A black and white sign with white text

AI-generated content may be incorrect.Close up of an owl's eye

AI-generated content may be incorrect.

AGENDA

Ordinary Te Koukou - Transport and Infrastructure Committee Meeting

Tuesday, 25 February 2025

Time:

10:00 AM

Location:

Council Chamber

Memorial Ave

Kaikohe

Membership:

Kahika Moko Tepania - Chairperson

Deputy Chairperson Steve McNally

Kōwhai - Deputy Mayor Kelly Stratford

Cr Felicity Foy

Cr Ann Court

Cr Hilda Halkyard-Harawira

Cr Babe Kapa

Cr Penetaui Kleskovic

Cr Tāmati Rākena

Cr Mate Radich

Cr John Vujcich

A logo for a company

Authorising Body

Mayor/Council

Status

Standing Committee

COUNCIL COMMITTEE

Title

Te Koukou - Transport and Infrastructure Committee
Terms of Reference

Approval Date

11 April 2023

Responsible Officer

Head of Infrastructure Strategy

Kaupapa / Purpose

The purpose of Te Koukou Transport and Infrastructure Committee (the Committee) is to ensure cost effective, quality and sustainable infrastructure decisions are made to meet the current and future needs of Far North communities and that Councils infrastructure assets are effectively maintained and operated.

The Committee will review the effectiveness of the following aspects:

•        Affordable core infrastructure to support healthy and sustainable living;

•        Operational performance including monitoring and reporting on significant infrastructure projects

•        Delivery of quality infrastructure and district facilities

•        Financial spend and reprogramming of capital works

•        Property and other assets

To perform his or her role effectively, each Committee member must develop and maintain his or her skills and knowledge, including an understanding of the Committee’s responsibilities, Councils’ infrastructure assets such as roading, three waters and district facilities.

Ngā Huānga / Membership

The Committee will comprise of all Mayor and Councillors.

Kahika Mayor Tepania

Kōwhai Deputy Mayor Kelly Stratford

John Vujcich

Ann Court

Babe Kapa

Felicity Foy

Hilda Halkyard-Harawira

Mate Radich

Penetaui Kleskovic

Steve McNally

Tāmati Rākena

Kōrama / Quorum

The quorum at a meeting of the Committee is 6 members.

Ngā Hui / Frequency of Meetings

The Committee shall meet 4 weekly.

Ngā Apatono / Power to Delegate

The Committee may not delegate any of its responsibilities, duties or powers.

Ngā Herenga Paetae / Responsibilities

The Committees responsibilities are described below:

Quality infrastructure and Facilities

Significant Projects – spend, monitoring and reporting

Compliance

Service levels (non regulatory)

Relationships

Property

Transport

Receive updates on changes to national and regional policies and Transport Plans that impact on Council provision of infrastructure and where appropriate make submissions or recommendation to Council.

Ngā Ture / Rules and Procedures

Council’s Standing Orders and Code of Conduct apply to all meetings.

Ordinary Te Koukou - Transport and Infrastructure Committee Meeting Agenda

25 February 2025

Far North District Council

Ordinary Te Koukou - Transport and Infrastructure Committee Meeting

will be held in the Council Chamber, Memorial Ave, Kaikohe on:

Tuesday 25 February 2025 at 10:00 AM

Te Paeroa Mahi / Order of Business

1        Karakia Tīmatanga / Opening Prayer. 9

2        Ngā Whakapāha Me Ngā Pānga Mema / Apologies and Declarations of Interest 9

3        Ngā Tono Kōrero / Deputation. 9

4        Te Whakaaetanga o Ngā Meneti o Mua / Confirmation of Previous Minutes. 10

4.1         Confirmation of Previous Minutes. 10

5        Ngā Pūrongo / Reports. 17

5.1         Transport Portfolio Member Reports. 17

5.2         Water Portfolio Member Reports. 20

6        Ngā Pūrongo Taipitopito / Information Reports. 21

6.1         Te Koukou Open Resolutions Update February 2025. 21

6.2         Infrastructure Consent Compliance Status. 23

6.3         Infrastructure Abatement Notices. 32

6.4         Infrastructure Working Group Updates. 37

6.5         Infrastructure Consenting Status Report 44

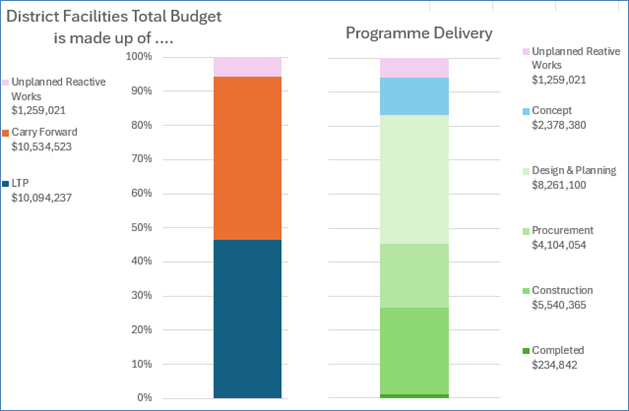

6.6         Capital Works Programme Delivery Update. 50

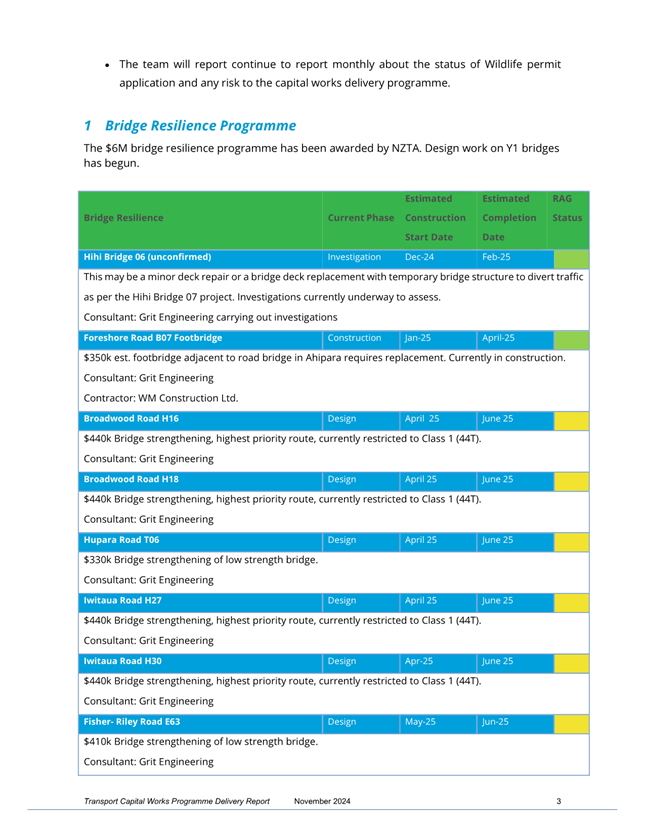

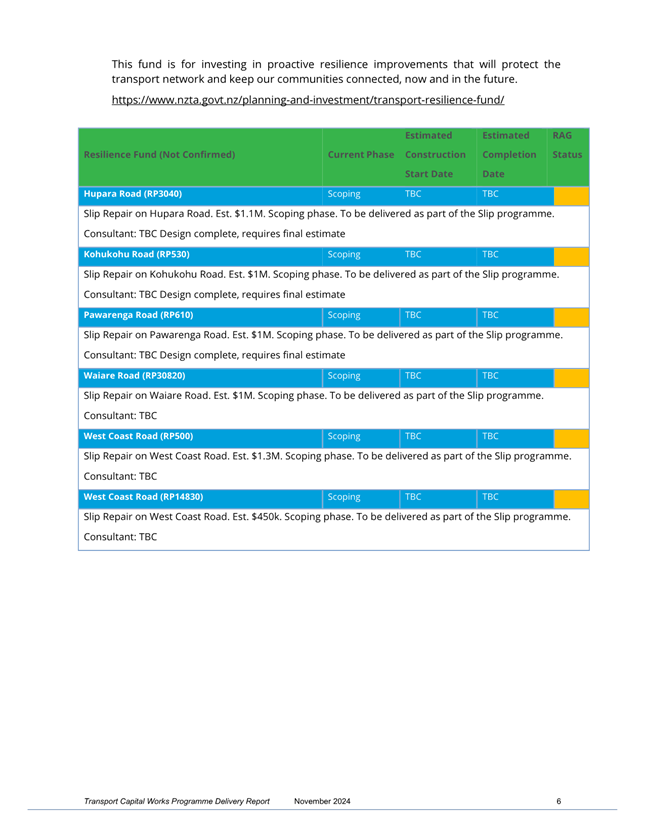

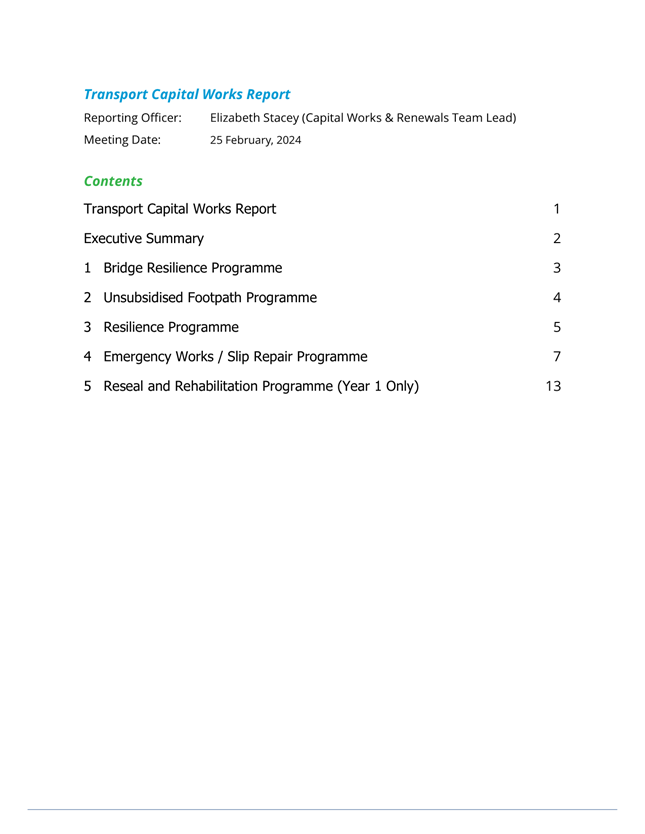

6.7         Road Safety Education and Engineering Update. 57

6.8         Transport Capital Works Programme Update. 60

6.9         North Hokianga Working Group Roading Update. 75

6.10       Transportation Maintenance and Renewals Activity Update December 2024. 90

6.11       Transportation Hokianga Ferry Service Contract December 2024 Update. 130

7        Te Wāhanga Tūmataiti / Public Excluded. 132

7.1         Confirmation of Previous Minutes - Public Excluded. 132

7.2         Kawakawa Infrastructure Acceleration Fund - Detailed Design Procurement 132

8        Karakia Whakamutunga / Closing Prayer. 133

9        Te Kapinga Hui / Meeting Close. 133

1            Karakia Tīmatanga / Opening Prayer

2            Ngā Whakapāha Me Ngā Pānga Mema / Apologies and Declarations of Interest

Members need to stand aside from decision-making when a conflict arises between their role as a Member of the Committee and any private or other external interest they might have. This note is provided as a reminder to Members to review the matters on the agenda and assess and identify where they may have a pecuniary or other conflict of interest, or where there may be a perception of a conflict of interest.

If a Member feels they do have a conflict of interest, they should publicly declare that at the start of the meeting or of the relevant item of business and refrain from participating in the discussion or voting on that item. If a Member thinks they may have a conflict of interest, they can seek advice from the Chief Executive Officer or the Manager - Democracy Services (preferably before the meeting).

It is noted that while members can seek advice the final decision as to whether a conflict exists rests with the member.

3            Ngā Tono Kōrero / Deputation

·         Inge Friday and Jen Hotere, providing feedback and support regarding the Otta seal trial in Ōtaua.

Ordinary Te Koukou - Transport and Infrastructure Committee  Meeting Agenda

25 February 2025

4            Te Whakaaetanga o Ngā Meneti o Mua / Confirmation of Previous Minutes

4.1         Confirmation of Previous Minutes

File Number:           A5044424

Author:                    Maria Bullen, Democracy Advisor

Authoriser:             Aisha Huriwai, Manager - Democracy Services

Take Pūrongo / Purpose of the Report

The minutes are attached to allow the Committee to confirm that the minutes are a true and correct record of previous meetings.

tŪtohunga / Recommendation

That Te Koukou – Transport and Infrastructure Committee confirm the minutes of the meeting held 26 November 2024 are true and correct.

1) TĀhuhu kŌrero / Background

Local Government Act 2002 Schedule 7 Section 28 states that a local authority must keep minutes of its proceedings. The minutes of these proceedings duly entered and authenticated as prescribed by a local authority are prima facie evidence of those meetings.

2) matapaki me NgĀ KŌwhiringa / Discussion and Options

The minutes of the meetings are attached.

Far North District Council Standing Orders Section 27.3 states that no discussion shall arise on the substance of the minutes in any succeeding meeting, except as to their correctness.

TAKE TŪTOHUNGA / REASON FOR THE RECOMMENDATION

The reason for the recommendation is to confirm the minutes are a true and correct record of the previous meetings.

3) PĀnga PŪtea me ngĀ wĀhanga tahua / Financial Implications and Budgetary Provision

There are no financial implications or the need for budgetary provision as a result of this report.

Attachments

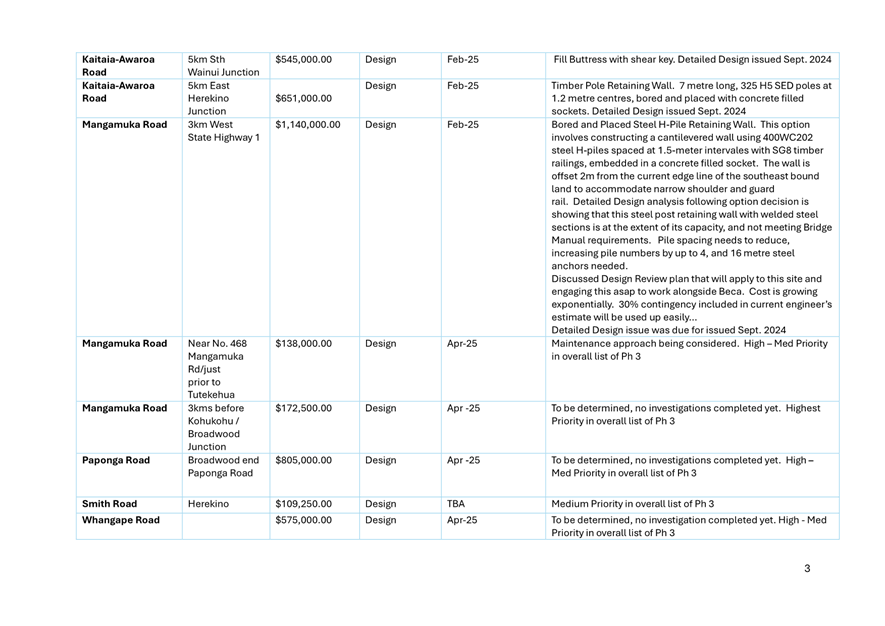

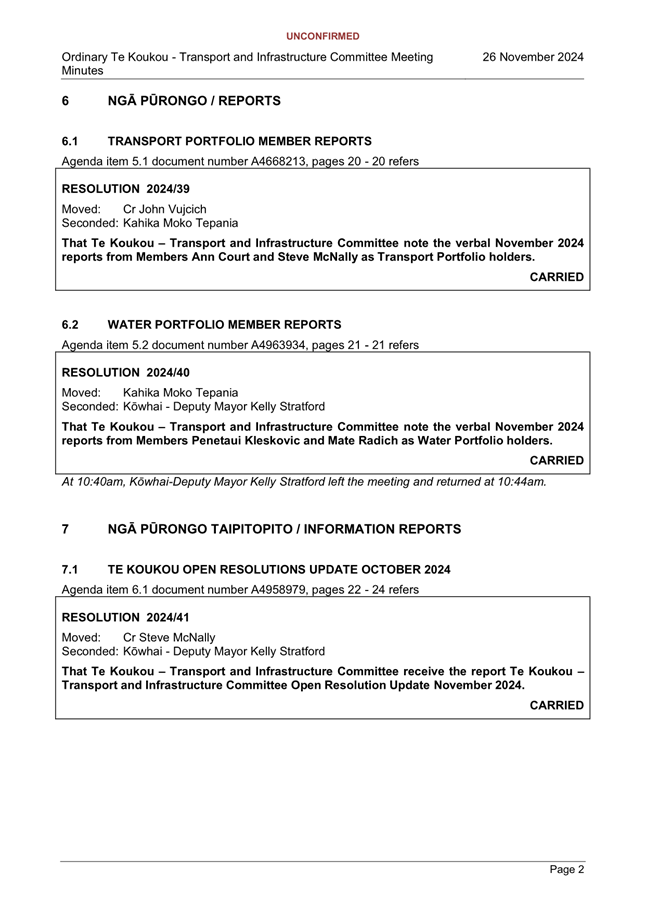

1.       2024-11-26 Te Koukou - Transport and Infrastructure Committee Minutes - A4998926

Hōtaka Take Ōkawa / Compliance schedule:

Full consideration has been given to the provisions of the Local Government Act 2002 S77 in relation to decision making, in particular:

1.       A Local authority must, in the course of the decision-making process,

a)      Seek to identify all reasonably practicable options for the achievement of the objective of a decision; and

b)      Assess the options in terms of their advantages and disadvantages; and

c)      If any of the options identified under paragraph (a) involves a significant decision in relation to land or a body of water, take into account the relationship of Māori and their culture and traditions with their ancestral land, water sites, waahi tapu, valued flora and fauna and other taonga.

2.       This section is subject to Section 79 - Compliance with procedures in relation to decisions.

He Take Ōkawa / Compliance Requirement

Aromatawai Kaimahi / Staff Assessment

State the level of significance (high or low) of the issue or proposal as determined by the Council’s Significance and Engagement Policy

This is a matter of low significance.

State the relevant Council policies (external or internal), legislation, and/or community outcomes (as stated in the LTP) that relate to this decision.

This report complies with the Local Government Act 2002 Schedule 7 Section 28.

State whether this issue or proposal has a District wide relevance and, if not, the ways in which the appropriate Community Board’s views have been sought.

It is the responsibility of each meeting to confirm their minutes therefore the views of another meeting are not relevant.

State the possible implications for Māori and how Māori have been provided with an opportunity to contribute to decision making if this decision is significant and relates to land and/or any body of water.

There are no implications for Māori in confirming minutes from a previous meeting. Any implications on Māori arising from matters included in meeting minutes should be considered as part of the relevant report.

Identify persons likely to be affected by or have an interest in the matter, and how you have given consideration to their views or preferences (for example, youth, the aged and those with disabilities).

This report is asking for minutes to be confirmed as true and correct record, any interests that affect other people should be considered as part of the individual reports.

State the financial implications and where budgetary provisions have been made to support this decision.

There are no financial implications or the need for budgetary provision arising from this report.

Chief Financial Officer review.

The Chief Financial Officer has not reviewed this report.

Ordinary Te Koukou - Transport and Infrastructure Committee  Meeting Agenda

25 February 2025

A document with text on it

AI-generated content may be incorrect.

A close-up of a document

AI-generated content may be incorrect.

A close-up of a document

AI-generated content may be incorrect.

A document with text and images

AI-generated content may be incorrect.

A close-up of a document

AI-generated content may be incorrect.

Ordinary Te Koukou - Transport and Infrastructure Committee  Meeting Agenda

25 February 2025

5            Ngā Pūrongo / Reports

5.1         Transport Portfolio Member Reports

File Number:           A5044557

Author:                    Maria Bullen, Democracy Advisor

Authoriser:             Aisha Huriwai, Manager - Democracy Services

Te Take Pūrongo / Purpose of the Report

To note the verbal reports from Transport Portfolio holders. The verbal reports provide feedback to Te Koukou – Transport and Infrastructure Committee on matters of interest or concern to the Committee.

ngĀ tŪtohunga / Recommendation

That Te Koukou – Transport and Infrastructure Committee note the verbal February 2025 reports from Members Ann Court and Steve McNally as Transport Portfolio holders.

1) te TĀhuhu kŌrero / Background

Te Koukou – Transport and Infrastructure Committee Chair Kahikā-Mayor Tepania allows members reports as a mechanism to have open communication and transparency on activities undertaken by the Transport Portfolio Members of the Te Koukou – Transport and Infrastructure Committee.

2) Te matapaki me NgĀ KŌwhiringa / Discussion and Options

Member reports are provided verbally during the meeting.

REASON FOR THE RECOMMENDATION

To formally receive the Member verbal reports.

3) NgĀ PĀnga PŪtea me ngĀ wĀhanga tahua / Financial Implications and Budgetary Provision

There are no financial implications or the need for budgetary provision as a result of this report.

ngĀ Āpitihanga / Attachments

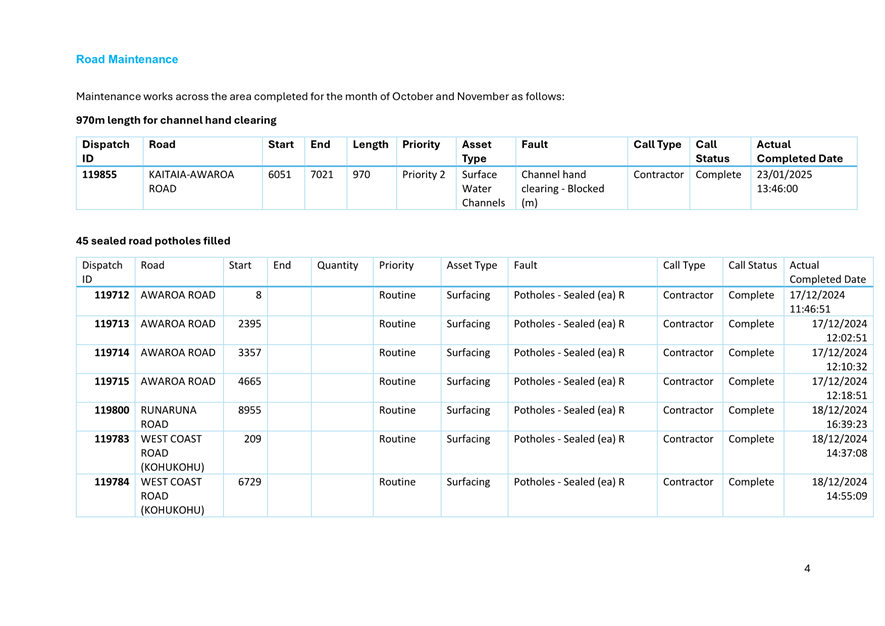

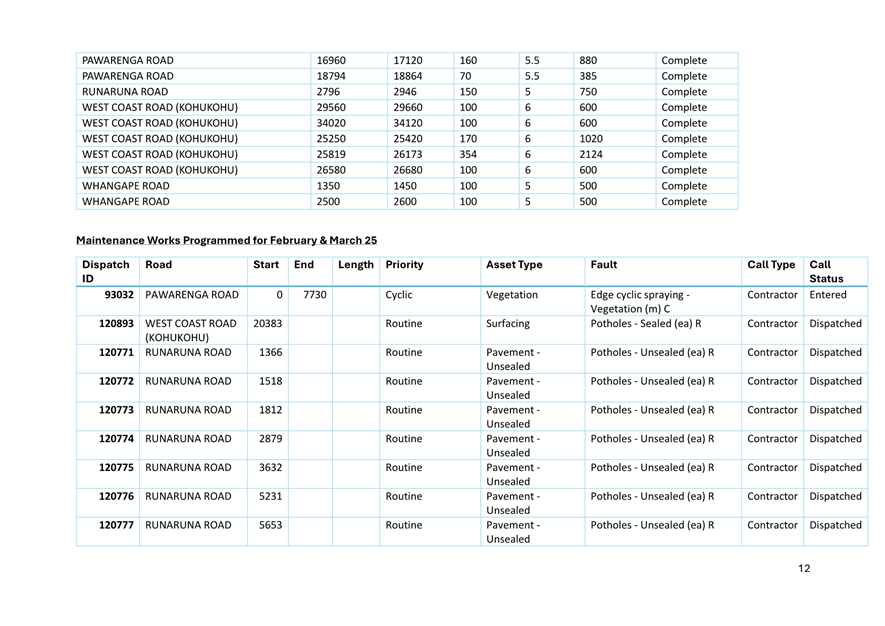

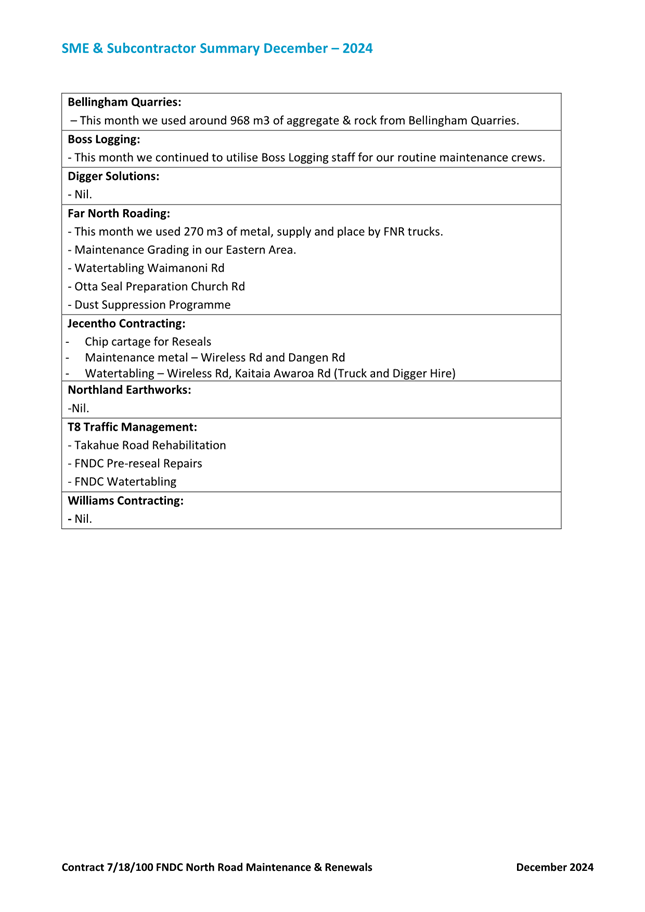

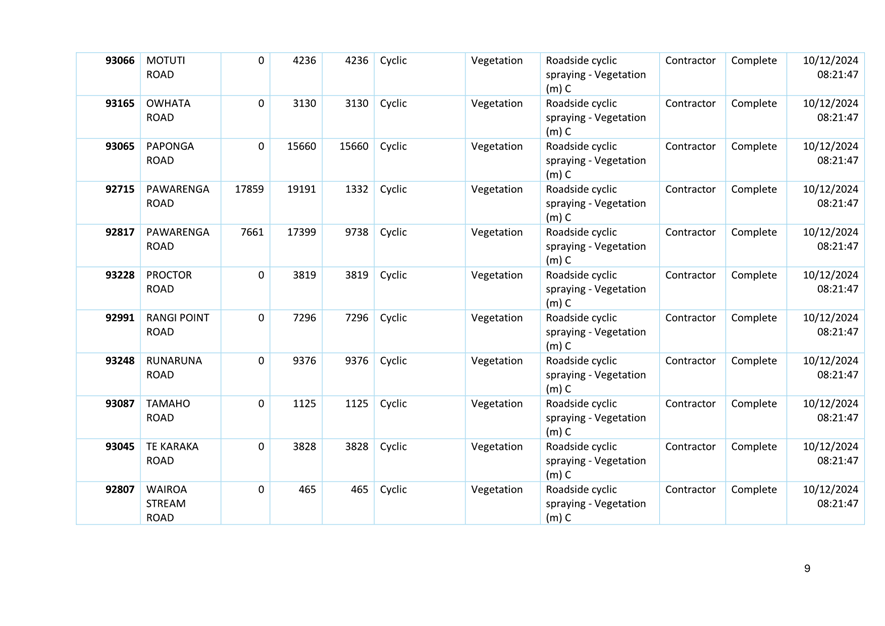

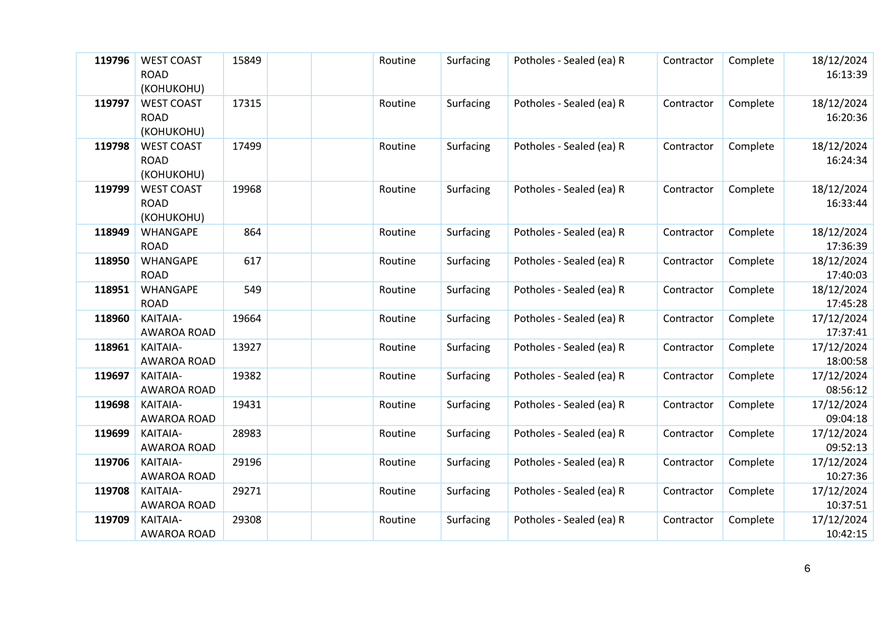

1.       Reallocation of local Share 2024-25 Road Maintenance Programme - A5087065

Ordinary Te Koukou - Transport and Infrastructure Committee Meeting Agenda

25 February 2025

A close-up of a document

AI-generated content may be incorrect.

A close-up of a document

AI-generated content may be incorrect.

Ordinary Te Koukou - Transport and Infrastructure Committee Meeting Agenda

25 February 2025

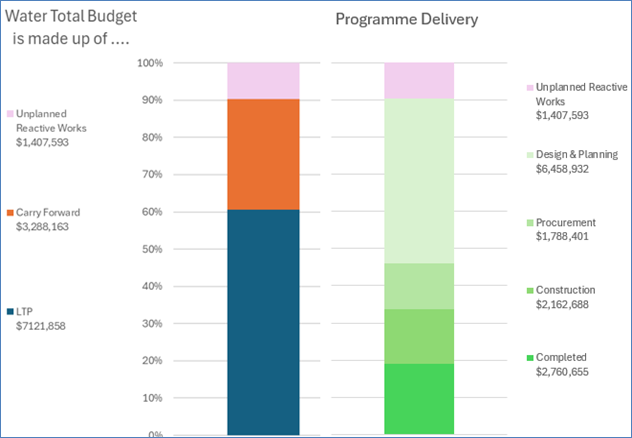

5.2         Water Portfolio Member Reports

File Number:           A5044537

Author:                    Maria Bullen, Democracy Advisor

Authoriser:             Aisha Huriwai, Manager - Democracy Services

Te Take Pūrongo / Purpose of the Report

To note the verbal reports from Water Portfolio holders. The verbal reports provide feedback to Te Koukou – Transport and Infrastructure Committee on matters of interest or concern to the Committee.

ngĀ tŪtohunga / Recommendation

That Te Koukou – Transport and Infrastructure Committee note the verbal February 2025 reports from Members Penetaui Kleskovic and Mate Radich as Water Portfolio holders.

1) te TĀhuhu kŌrero / Background

Te Koukou – Transport and Infrastructure Committee Chair Kahikā-Mayor Tepania allows members reports as a mechanism to have open communication and transparency on activities undertaken by the Water Portfolio Members of the Te Koukou – Transport and Infrastructure Committee.

2) Te matapaki me NgĀ KŌwhiringa / Discussion and Options

Member reports are provided verbally during the meeting.

REASON FOR THE RECOMMENDATION

To formally receive the Member verbal reports.

3) NgĀ PĀnga PŪtea me ngĀ wĀhanga tahua / Financial Implications and Budgetary Provision

There are no financial implications or the need for budgetary provision as a result of this report.

ngĀ Āpitihanga / Attachments

Nil

Ordinary Te Koukou - Transport and Infrastructure Committee Meeting Agenda

25 February 2025

6            Ngā Pūrongo Taipitopito / Information Reports

6.1         Te Koukou Open Resolutions Update February 2025

File Number:           A5044469

Author:                    Maria Bullen, Democracy Advisor

Authoriser:             Aisha Huriwai, Manager - Democracy Services

Take Pūrongo / Purpose of the Report

To provide Te Koukou – Transport and Infrastructure Committee with an overview of outstanding Te Koukou – Transport and Infrastructure Committee and the previous term Committee decisions from 1 January 2018.

WhakarĀpopoto matua / Executive Summary

·        Open resolutions are a mechanism to communicate progress against decisions/resolutions.

·        Open resolutions are also in place for all formal elected member meetings.

tŪtohunga / Recommendation

That Te Koukou – Transport and Infrastructure Committee receive the report Te Koukou – Transport and Infrastructure Committee Open Resolution Update February 2025.

1) TĀhuhu kŌrero / Background

Any resolution or decision from a meeting is compiled on an open resolution status report, to capture actions trigged by Te Koukou – Transport and Infrastructure Committee decisions. Staff provide updates on progress against tasks that are not yet completed.

2) matapaki me NgĀ KŌwhiringa / Discussion and Options

The outstanding tasks are often multi-facet projects that take longer to fully complete. Where a decision differs to the recommendation of staff there may be unintended consequences or challenges that take longer for staff to work through.

TAKE TŪTOHUNGA / REASON FOR THE RECOMMENDATION.

To provide Te Koukou – Transport and Infrastructure Committee with an overview of outstanding Te Koukou – Transport and Infrastructure Committee decisions from 1 January 2018.

3) PĀnga PŪtea me ngĀ wĀhanga tahua / Financial Implications and Budgetary Provision

There are no financial implications or need for budgetary provision in receiving this report.

Āpitihanga / Attachments

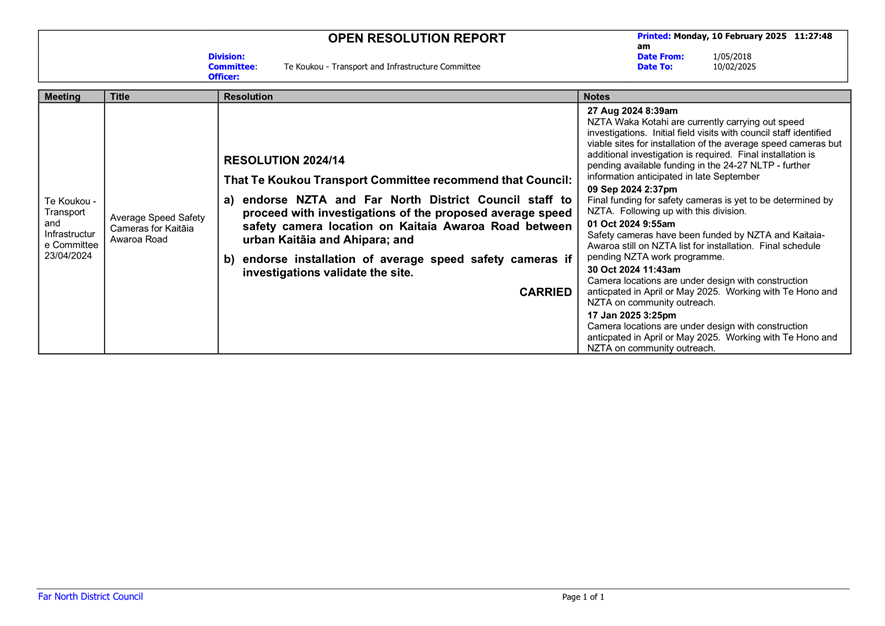

1.       Open Resolution Report - A5075052

Ordinary Te Koukou - Transport and Infrastructure Committee Meeting Agenda

25 February 2025

A screenshot of a computer

AI-generated content may be incorrect.

Te Koukou - Transport and Infrastructure Committee Meeting Agenda

25 February 2025

6.2         Infrastructure Consent Compliance Status

File Number:           A5034706

Author:                    Doug Astill, Compliance Officer - Infrastructure Services

Authoriser:             Tanya Proctor, Head of Infrastructure

TAKE PŪRONGO / Purpose of the Report

The purpose of this information report is to report the compliance status achieved of all infrastructure consents granted by Northland Regional Council since the last Te Koukou Committee meeting.

WHAKARĀPOPOTO MATUA / Executive SummarY

·        Council holds multiple resource consents, as required by the provisions of the Resource Management Act 1991, for the operation of water, wastewater and district facility assets.

·        Compliance is measured across all consent conditions, including reporting. Failure to submit a report on time can therefore result in a non-compliant status.

·        Water and wastewater consent condition compliance is reported to Northland Regional Council monthly, while stormwater is reported annually.

·        As at December 2024 all of Council’s eight water treatment plants were fully compliant, while four of Council’s 15 wastewater treatment plants were fully compliant.

·        A total of seven Abatement Notices had been received by 31 December 2024 - Water (3), Wastewater (1), District Facilities (2), and Solid Waste (1) - and these are detailed in a separate information report, Infrastructure Abatement Notices, on this meeting agenda.

·        District Facilities related consent conditions (maritime/airports, sports facilities, public toilets, landfills, campgrounds) are newly reported on by the Infrastructure Group.

 TŪTOHUNGA / Recommendation

That Te Koukou - Transport and Infrastructure Committee receive the report Infrastructure Consent Compliance Status.

tĀHUHU KŌRERO / Background

Council holds multiple resource consents, as required by the provision of the Resource Management Act 1991, for the operation of Water, Wastewater, Stormwater and District Facilities infrastructure. District Facilities infrastructure includes maritime and airports, solid waste (landfills), and onsite wastewater for public toilets, sports facilities, and campgrounds.

Compliance reporting to Northland Regional Council of water and wastewater consent conditions is monthly (15th) via email, while stormwater discharges are reported annually each July.

Reporting of all other consent conditions is as required by the consent. Compliance is measured across all consent conditions, including reporting, for which failure to submit a report on time can be the single cause of non-compliance.

Due to reporting timeframes the Compliance Status report provided to the October 2024 Te Koukou Committee meeting only included results to August 2024. This report includes the results of September - December 2024.

The October 2024 Committee meeting requested the following information to be provided to the next meeting:

·    follow up with the operations and maintenance team to understand why information was not provided in Table 1 as shown with the question mark symbol.

·    provide regular reports on yellow and red dots highlighted in Table 1 to understand the issue and approach moving forward to mitigate the issue.

·    provide a list of non-compliances for wastewater and water takes to understand what non-compliances are administrative and what are quality related.

MATAPAKI ME NGĀ KŌWHIRINGA / Discussion and Next Steps

An update responding to the October 2024 Committee meeting request for information is tabled below.

October 2024 Te Koukou meeting request

Status

Follow up with the operations and maintenance team to understand why information was not provided in the dot report (Table 1) as shown with the question mark symbol.

Data reporting error in telemetry system. Confirmed with operator this has been addressed.

Compliance Officer to implement data point exceedance notifications from reporting platform.

Provide regular reports on yellow and red dots highlighted in Table 1 to understand the issue and approaches moving forward to mitigate the issue.

A workshop presentation is being prepared for presentation to Te Koukou Committee meeting workshops commencing March 2025.

Provide a list of non-compliances for water takes and wastewater treatment plants to understand what non-compliances are administrative and what are quality related.

Table 2: Compliance status for water takes and wastewater discharges for December 2024 refers.

Analysis of consents and consent conditions

CSVue is a nationwide software system that Council uses to hold its consent details. A review of all 3water consents and consent condition data has highlighted some discrepancies in the data setup. These discrepancies may result in CSVue reporting incorrect consent condition compliance. The following steps are being taken to mitigate this risk:

·        Validate the status with of all waters consents with Northland Regional Council

·        Validate and update the data in CSVue for all consents and consent conditions

·        Audit all non-waters consents and conditions.

This programme of work is expected to be completed by May 2025.

Compliance status for all waters consents to 31 December 2024

Table 1 is a rolling 12-month dot report which indicates the compliance status of water quality and flow for Council’s water takes and wastewater treatment plants is tabled below.

Table 1: Compliance status for water quality and flow

Key:

Non-compliant and has an abatement notice in place

Non-compliant but not subject to an abatement notice or enforcement action

Complied with water quality and flow data requirements for the month

There may still be administrative non-compliances that are not reported on at a monthly level

Compliance not reported due to no data being provided

Sites

Dec 23

Jan 24

Feb 24

Mar 24

Apr 24

May 24

Jun 24

Jul 24

Aug 24

Sep 24

Oct 24

Nov 24

Dec24

Kaitāia water

Kaikohe water

Kawakawa water

Rāwene/Ōmanaia water

Kerikeri water

 ●

Okaihau water

Ōpononi water

Paihia water

Ahipara wastewater

Hihi wastewater

Kāeo wastewater

Kaikohe wastewater

Kaitāia wastewater

Kawakawa wastewater

Kerikeri wastewater

Kohukohu wastewater

Ōpononi wastewater

Paihia wastewater

Rāwene wastewater

Rangiputa wastewater

Kororāreka/Russell wastewater

Taipā wastewater

Whatuwhiwhi wastewater

Abatement Notices

Seven abatement notices were received between October and December 2024.

At 31 December 2024 a total of 10 abatement notices were outstanding - Water (3), Wastewater (4), District Facilities (2), and Solid Waste (1). Of the three Water abatement notices, none relate to an operational treatment plant - two are for water take instrumentation and data issues and one was issued in error for a facility that has not been in use for several years.

A separate information report - Infrastructure Abatement Notices - on this meeting agenda details of abatement notices and the mitigations in progress to achieve compliance and have the notices cancelled.

A risk analysis of these abatement notices has been completed and a report - Resource Consent Abatement Notice Risk Update - has been prepared for the February 2024 Te Miromiro Committee meeting.

List of non-compliances for water takes and wastewater discharges

Table 2 provides a list of water takes and wastewater discharges with non-compliances together with the relevant consent conditions to determine whether the non-compliance is due to an administrative or quality related issue.

This information was requested at the October 2024 Te Koukou Committee meeting.

Table 2: Compliance status for water takes and wastewater discharges for December 2024

Key:

Red

Frequent non-compliance and enforcement action has been taken (abatement, infringement, or prosecution)

Amber

Frequent non-compliances but no enforcement action taken

Green

Fully compliant

White

Administrative/report non-compliant

Sites

Water Flow and Quality Conditions (compliance status)

Outstanding Administrative and Reporting Conditions

Water Take Consents

Kaitāia

Awanui River water take compliant 12 of last 12 months.

Sweetwater Bore not yet in production so is not reported here.

This scheme has two water takes, Awanui River and Sweetwater Bore. The bore take is not yet in production.

Awanui River

·    Condition 5 - meter verifications due every 5 years

·    Condition 11 - form Iwi liaison group

Sweetwater Bore (not yet in production)

·    Condition 17 - provide annual report

·    Condition 18 - form and operate water user liaison group

Kaikohe

Monument Hill Bore and Wairoro Stream water takes compliant 12 of last 12 months

This scheme has three water take consents, Monument Hills Bore, Wairoro Stream and Taraire Hills Dam.

Monument Hill

·    Condition 10 - install and maintain water level or flow measuring devices at the Waikotihe Spring and the Punakitere Stream at the monitoring locations marked on the (attached) plan (referenced as Northland Regional Council Plan Number 5078)

Wairoro Stream

·    Condition 4 - meter verification due every 5 years

Taraiare Hills Dam

·    Nil

Kawakawa

Tirohanga Bore take compliant 12 of last 12 months

Tirohanga Bore

·    Condition 4 - meter verification due every 5 years

Rāwene Ōmanaia

Petaka Stream take compliant 5 of last 12 months

Compliant for December 2024

·    Condition 18 - supernatant monitoring

·    Condition 22 - maintenance records to be maintained and provided to Northland Regional Council immediately upon request

·    Condition 30 - community liaison group to be established and facilitated

Kerikeri

Kerikeri water take compliant 11 of last 12 months.

Compliant for December 2024

·    Condition 4 -  meter verifications due every 5 years

Ōkaihau

Ōkaihau bore water take compliant 12 out of last 12 months

Ōkaihau Bore

·    Condition 7 - maintain the water supply reticulation network and treatment system so that it operates effectively at all times and the loss of water from the reticulation network and treatment system is, as far as is practicable, minimised. A record of all maintenance shall be available to view by the Northland Regional Council’s assigned monitoring officer immediately on written request by that officer.

Ōpononi

Smoothy Bore and Waiotemarama Stream take compliant 8 out of last 12 months

This scheme has three water takes, Waiotemarama Stream, Smoothy Bore, and Waiorohia Dam. The dam is not currently in use.

Waiotemarama Stream

·    Condition 14 - community liaison group to be established and facilitated to meet at least annually

Smoothy Bore

·    Condition 12 - Leighs Spring monitoring required

Paihia

Waitangi River water take compliant 11 out of last 12 months. Non-compliant in December 2023 because flow meter was not operating. Now resolved.

Full Compliance

Wastewater Discharge Consents

Ahipara

Condition 10 - Faecal coliforms have caused non-compliance 12 of last 12 months. SCUV has now been installed and water quality is achieving compliance. Abatement notice will not be removed until 6 months of compliance achieved.

Condition 2 - leachate volume of 11m3 exceeds consented level of 10m3

·    Condition 4 - meter verifications required annually

·    Condition 20 - servicing and maintenance records required annually

·    Condition 21 - wastewater management plan review required every three years

Hihi

Non-compliance due to E. coli and ammonia breaches

Compliant from August 2024 following completion of upgrade works.

·    Condition 10 - inflow and infiltration prevention

·    Condition 16 - Annual Management Plan review

Kāeo

Non-compliant due to missing flow data and E. coli and ammonia breaches 9 of last 12 months.

Compliant in December

·    Condition 11 - new trade and industrial connections to be reported to Northland Regional Council

·    Condition 12 - servicing and maintenance records required annually

Kaikohe

Non-compliant due to E. coli and or ammonia 12 of last 12 months (condition 7(h))

·    Condition 2 - outlet flow meter accuracy

·    Condition 9 - inflow and infiltration prevention

·    Condition 11 - inlet screen replacement and operation

Kaitāia

Non-compliant due to either missing flow data or bacteriophages 10 of last 12 months.

Condition 6(b) regarding bacteriophages non-compliant in December

·    Condition 9 - inflow and infiltration prevention

·    Condition14 - wastewater management plan review required every five years

Kawakawa

Non-compliant due to E. coli 3 of last 12 months

Compliant October - December

·    Condition 12 - annual monitoring report

·    Condition 13 - wastewater management plan review required every three years

Kerikeri

Compliant 12 of 12 months

·    Condition 15 - servicing and maintenance records required annually

·    Condition 18 - community liaison group to be established and facilitated to meet at least annually.

·    Condition 19 - provide monitoring reports to community liaison group

Kohukohu

Non-compliant for either flow or E. coli  9 12 of last 12 months

Condition 23 - faecal coliforms exceeded 50th percentile of 5000mpn/100ml

·    Condition 2 - system management plan finalised with community liaison group

·    Condition 12 - establish Terms of Reference for a community liaison group

·    Condition 27 - odour management plan to be finalised with community liaison group

Ōpononi

Non-compliant for E. coli 11 of last 12 months

Condition 19 – E. coli breached median limit of 3000mpn/100ml

·    Condition 5 - meter verification due annually

·    Condition 7 - tidal clock calibration

·    Condition 21 - community liaison group to be established and facilitated to meet at least annually

Paihia

Non-compliant for ammonia 6 out of last 12 months

Compliant October -December

·    Condition 1 - inflow meter not working

 Rāwene

Non-compliant TSS and faecal 12 of last 12 months

Note DNA testing of faecal coliforms indicates some contamination coming from birds

Condition 8 – TSS and faecal coliforms exceeding med12 limit

·    Condition 5 - meter verification due annually

Rangiputa

Non-compliant 1 month out of last 12 due to inflow meter failure - now resolved.

Russell

Non-compliant 9 out of 12 months due to E.coli and leachate flow

E.coli has resolved since installation of new UV

Non-compliant in December due to

·    Condition 8 - land instability report

·    Condition 9 - bore disposal monitoring and maintenance report

·    Condition 10 - inflow and infiltration prevention programme

·    Condition 11 - infiltration and inflow investigation work

Taipā

 Non-compliant for ammonia and faecal coliforms 12 out of last 12 months.

DNA testing indicates coliforms may be from birds

Condition 5 – fecal coliforms exceed 850cfu/100ml at constructed wetland

·    Condition 11 - advised Northland Regional Council of commitment to discharge to land which invokes Condition 12

·    Condition 12 - establish and commission discharge to land no late than 1 September 2027

Whatuwhiwhi

Non-compliant for total suspended solids (TSS) 12 out of last 12 months.

Condition 8 – TSS exceeded 30 gms/m3

·    Condition 8 - TSS exceeded 30 gms/m3

Ordinary Te Koukou - Transport and Infrastructure Committee Meeting Agenda

25 February 2025

PĀNGA PŪTEA ME NGĀ WĀHANGA TAHUA / Financial Implications and Budgetary Provision

This is an information report of resource consent compliance status and as such does not have any direct financial implications or budgetary provision.

Āpitihanga / Attachments

Nil

Ordinary Te Koukou - Transport and Infrastructure Committee Meeting Agenda

25 February 2025

6.3         Infrastructure Abatement Notices

File Number:           A5034709

Author:                    Doug Astill, Compliance Officer - Infrastructure Services

Authoriser:             Tanya Proctor, Head of Infrastructure

TAKE PŪRONGO / Purpose of the Report

The purpose of this information report is to report new Abatement Notices received together with progress made towards achieving compliance and cancellation of all outstanding infrastructure related Abatement Notices issued by the Northland Regional Council.

WHAKARĀPOPOTO MATUA / Executive SummarY

·        Non-compliance and addressing enforcement action is a key priority for Council.

·        Reporting now includes District Facilities infrastructure Abatement Notices.

·        Seven Abatement Notices were received between September and December 2024, taking the total number of outstanding to eleven.

·        Separate reporting to Te Miromiro Committee addresses the risk aspect of enforcement action.

·        Monthly updates on remediation works to address Abatement Notices will be provided to Northland Regional Council.

 TŪTOHUNGA / Recommendation

That Te Koukou - Transport and Infrastructure Committee receive the report Infrastructure Abatement Notices.

tĀHUHU KŌRERO / Background

Council holds multiple resource consents, as required by the provision of the Resource Management Act 1991, for the operation of Water, Wastewater, Stormwater and District Facilities infrastructure. District Facilities infrastructure includes maritime and airports, solid waste (landfills), and onsite wastewater for public toilets, sports facilities, and campgrounds.

Northland Regional Council is the Compliance Regulator for the Resource Management Act 1991 (the RMA). Any activity that contravenes or is likely to contravene the RMA, (any Regulations, a Rule in a plan or a resource consent) can result in enforcement action such as an Abatement Notice being issued - s322(1)(a)(i).

Non-compliance and addressing enforcement action is a key priority for Council.

A separate report outlining the compliance status achieved of all infrastructure consents granted by Northland Regional Council since the last Te Koukou Committee meeting is included in the meeting agenda – Infrastructure Consent Compliance Status.

A risk analysis of Abatement Notices has been completed and a report - Resource Consent Abatement Notice Risk Update - has been prepared for the February 2025 Te Miromiro Committee meeting.

The last Infrastructure Abatement Notice report presented to Te Koukou in October 2024 reported on three Abatement Notices as at August 2024.

This update includes all Abatement Notice activity for the period September – December 2024 during which seven new Abatement Notices were received, taking the total number of outstanding to ten. These are summarised in Table 1 below.

Table 1: Outstanding Abatement Notices from NRC

Scheme

Issued Date

Notice Number

Reason

Ōpononi/Omāpere Wastewater Treatment Plant

20 April 2016

EAC.066718.01

The discharge from the WWTP was not complying with condition 19 of AUT.002667 in particular the E.coli median and 90 percentile levels.

Kaitāia Wastewater Network

20 April 2016

EAC.066717.01

The unconsented discharge of untreated wastewater from the Kaitāia reticulated wastewater network into the Tarawhaturoa Stream, Kaitāia.

Ahipara Wastewater Treatment Plant

5 September 2022

EAC.071083.01

As per condition 10, faecal coliform concentration exceeded the median and 90 percentile concentrations of the AUT.003775 limits.

Kohukohu Wastewater Treatment Plant

24 October 2024

EAC.072397.0

Ongoing non-compliance with faecal coliforms and ammonia levels.

Russell Landfill

1 Nov 2024

EAC.072442.01

Ongoing non-compliance with leachate volumes discharging to wastewater treatment plant.

Waitangi River

12 November 2024

EAC.072471.01

Lack of information on water take volume readings.

Awanui River

12 November 2024

EAC.072471.01

Lack of water flow meter verification.

Kerikeri Sports complex

6 December 2024

EAC.072537.01

Lack of wastewater reports.

Kerikeri Sports complex

17 December 2024

EAC.072537.01

Dripper line maintenance not up to level specified in consent.

Ōpononi Water

9 January 2025

EAC.072600.01

Lack of meter verification - issued in error as specified facility has not been in use for several years.

Pākāraka truck stop

Lack of discharge information.

MATAPAKI ME NGĀ KŌWHIRINGA / Discussion and Next Steps

Previous Infrastructure Abatement Notices reports have not included any Notices received for District Facilities infrastructure. These are now included, and Table 2 lists all Abatement Notices outstanding together with actions, progress, and expected completion dates.

Table 2: Abatement Notice programme of work

·

Scheme

Mitigation

Expected Completion

Progress

Compliant – Abatement Lifted

Ōpononi/Omāpere Wastewater Treatment Plant

Desludging of ponds and wetland reinstatement

February 2025

Mobilising to site and enabling works commenced in September 2024.

No

Installation of baffle curtains

June 2025

Final detailed design requires further testing to confirm mixing times for UV. Procurement process expected to commence March 2025.

Ultraviolet disinfection unit

Kaitāia Wastewater Network

Construct a new DN450 wastewater main between the Bank Street engineered overflow Point (EOP) and Bonnett Road.

Construct a new 500 m3 of emergency storage at Bonnett Road.

July 2025

Contract award approval on February 2025 Council agenda.

Construction to commence March 2025 with completion expected July 2025.

No

Ahipara Wastewater Treatment Plant

Installation and commissioning of SCUV treatment

Completed

Quality results show compliance is being achieved.

Abatement notice will not be lifted before 6 months of compliant water quality results are achieved.

No

Kohukohu Wastewater Treatment Plant

Bilge pump installed to aerate ponds.

De-sludging

of oxidation pond.

Install baffle curtains.

Correct sample results in Water Outlook.

June 2025 on completion of desludging and baffle curtain installation.

Desludging scheduled to commence February 2025

No

Russell Landfill

Telemetry data reporting to be installed.

Works to be undertaken to reduce leachate flow.

Awaiting scoping of investigation.

Confirming mitigation steps with Solid Waste management team.

No

Waitangi River

Confirmation has been provided to  Northland Regional Council of intention to comply.

Completed

Northland Regional Council to advise cancellation of Notice.

No

Awanui River

Flow meter reading received and relayed to Northland Regional Council.

Feb 2025

Northland Regional Council to advise cancellation of Notice.

No

Kerikeri Sports complex

Operations and maintenance manual to be updated and carried out, ensuring completed maintenance is recorded.

Feb 2025

Set up task for reporting, confirm staff remit.

No

Kerikeri Sports complex

Confirmed dripper line maintenance plan. Northland Regional Council updated.

Works commenced. Completion February 2025.

Confirm completion of works and inform Northland Regional Council

No

Ōpononi Water

Confirmed this facility is not in use.

Completed 21 Jan 2025

Commit to closer communication with Northland Regional Council to avoid errors.

Yes

21/01/2025

Pākāraka truck stop

Discharge information supplied to Northland Regional Council.

Completed

Northland Regional Council to advise cancellation of Notice.

No

PĀNGA PŪTEA ME NGĀ WĀHANGA TAHUA / Financial Implications and Budgetary Provision

This is an information report of outstanding Infrastructure Abatement Notices which are expected to be resolved without further enforcement action incurring unbudgeted expenditure. As such there are no direct financial implications or budgetary provision to report.

Āpitihanga / Attachments

Nil

Te Koukou - Transport and Infrastructure Committee Meeting Agenda

25 February 2025

6.4         Infrastructure Working Group Updates

File Number:           A5058022

Author:                    Doug Astill, Compliance Officer - Infrastructure Services

Authoriser:             Tanya Proctor, Head of Infrastructure

TAKE PŪRONGO / Purpose of the Report

The purpose of this information report is to provide an update to Te Koukou on the Infrastructure Working Groups.

WHAKARĀPOPOTO MATUA / Executive SummarY

·        Te Kaunihera o Te Hiku o Te Ika – Far North District Council have multiple working groups with iwi, hapū and community representatives.

·        To date there are 6 active working groups where Council are actively engaging.

·        There are several consents with conditions requiring working groups to be in place or sent regular updates. Under resourcing has been a contributing factor to non-compliances for this condition for some of these consents.

 TŪTOHUNGA / Recommendation

That Te Koukou - Transport and Infrastructure Committee receive the report Infrastructure Working Group Updates.

tĀHUHU KŌRERO / Background

Council has multiple working groups with iwi, hapū and community representatives. These working groups have been set up to provide input into infrastructure consent applications, infrastructure projects, or as a condition of a current consent.

MATAPAKI ME NGĀ KŌWHIRINGA / Discussion and Next Steps

Insufficiently resourcing working groups with appropriate representation, including meeting administration has resulted in some working groups not yet being established, which in turn can mean non-compliance for consents.

Table 1 outlines active Working Groups established to meet consent conditions.

Table 2 outlines Working Groups established through providing input into Council infrastructure consent applications.

Table 3 outlines non-active Working Groups required to meet consent conditions.

Table 1: Active Working Groups established to meet consent conditions

Consent Number & Scheme

Purpose of Consent

Condition #

Relevant working group condition

Membership

Current situation

Remediation

AUT.025683.01 Kaitāia Water Treatment Plant

To take up to 5,000 cubic metres of groundwater or 1,460,000 cubic metres yearly from 2 bores for the purposes of public water supply to the township of Kaitaia.

Condition 18

Council will ensure these annual meetings will be held in accordance with condition 18 of the Resource Consent. Once the first meeting is confirmed, Northland Regional Council will be notified.

·     Aupouri Groundwater users including Landcorp

·     Te Rūnanga o Te Rarawa

·     Mahimaru marae

·     Waimanoni marae (or their iwi representatives)

·     Consent Holder

·     Northland Regional Council

Iwi have received information updates. No meetings have taken place

Council will ensure these annual meetings will be held in accordance with condition 18 of the Resource Consent. Once the first meeting is confirmed, Northland Regional Council will be notified.

AUT.004007

East Coast* Bays Wastewater Treatment Plant (WWTP)

*Also known as Taipā

To undertake activities associated with the operation of the East Coast WWTP

Condition 7

The consent holder must no later than 1 October 2021 establish a working group…

·     3 representatives of Ngāti Kahu (appointed by mana whenua)

·     1 representative of the broader Doubtless Bay community (appointed by Te Mana o Te Wai hapū Integration Roopu Charitable Trust)

·     2 senior officers appointed by the Consent Holder

·     Supported by an independent person qualified and specialising in wastewater engineering and land disposal system

Council have been working with the Taipā working group to install an electro-coagulation trial and investigating discharge to land options.

AUT.002577 Rāwene WWTP

To undertake activities associated with the operation of a wastewater treatment system that services the township of Rāwene

Condition 19A

Within one month from the date of commencement of these consents, the Consent Holder shall assist in the formation of the community liaison group

·     Ngāti Kaharau hapū

·     Ngāti Hau ki Ōmanaia hapū

·     Te Māhurehure hapū

·     Te Hikutu hapū

·     Ngāti Korokoro

·     Ngāi Tūpoto hapū

·     Hokianga Community

·     Rāwene Community

The actual composition of the community liaison group is subject to invitees' willingness or availability to participate.

The community liaison group may appoint, or invite, other persons to participate.

There is an active working group for the Rāwene WWTP. Current work programme includes upgrading the plant with electro-coagulation by Better Off Funding.

Condition 21B

Within six months of the written report required by Condition 21A being provided to the Northland Regional Council and the Community Liaison Group, the Consent Holder shall, with the involvement of the Community Liaison Group, engage an appropriately qualified and experienced wastewater design professional, or environmental engineer, to investigate and report on options for the treatment and disposal of wastewater from the Rāwene area of benefit. The Consent Holder shall meet the costs of the investigation up to a maximum value of $15,000 excluding GST.

AUT.003839

Kohukohu WWTP

To undertake activities associated with the operation of a wastewater treatment system that services the township of Kohukohu.

Condition 9

Within one month of commencement of these Consents, the Consent Holder must invite representatives from the following groups to form a Community Working Group.

Te Ihutai Hapū, supported by Ngā hapū o Hokianga, Te Rūnanga o Te Rarawa, and Te Rūnanga a Iwi o Ngāpuhi; and the Kohukohu community (duly appointed).

The Community Working Group may appoint or invite other people to participate in meetings.

There have been 3 meetings to date with Tauteihiihi marae. A meeting has been scheduled for Feb 13th 2025. The group have been working to understand the current state of the Kohukohu WWTP. The group wanted to understand the current issues before working towards future alternative options for discharge.

Table 2: Working Groups established through providing input into FNDC infrastructure consent applications

Scheme

Membership

Status

Kaitāia Wastewater Treatment Plant (WWTP)

·    Ngai Tohianga/Ōturu Marae

·    Ngā hapū tokotoru o Pukepoto (Ngāti Te Ao, Te Uri o Hina, Te Tahawai)

·    Te Rūnanga o Te Rarawa

FNDC staff have been actively engaging with iwi and hapū and have proposed consent conditions for the formation of a kaitiaki forum.

Kaikohe WWTP

·    Ngā hapū o Kaikohekohe representatives:

Te Matarahurahu,

Ngāti Ueoneone,

Te Uri-O-Hua,

Takotoke,

Ngāti Kura,

Ngāti Tautahi,

·    Ngāti Whakaeke.

Keeping regular updates with the working group on plant upgrades.

Hihi WWTP

·    Waiaua Marae

·    Matarahurahu

Relationship was formed, but due to staff changes relationship needs to be reestablished.

Kāeo WWTP

·    Te Rūnanga o Whaingaroa

An email had been sent through to Kahukuraariki Trust and Ngāpuhi.

Relationship was formed, but due to staff changes relationship needs to be reestablished.

Table 3: Non-Active Working Groups required to meet consent conditions

Consent Number & Scheme

Purpose of Consent

Condition #

Relevant working group condition

Membership

Current situation

Remediation

AUT.003775 Ahipara WWTP

To undertake activities associated with the operation of the Ahipara Wastewater Treatment Plant.

Condition 24

The Consent Holder shall establish, convene and provide reasonable administrative support for a Community Liaison Group.

At least one representative from the following:

·     The Ahipara community;

·     Te Rūnanga O Te Rarawa;

·     Te lwi O Ngai Takoto;

·     The Ahipara Hapū Marae.

Keeping regular updates with the Ahipara Takiwā on plant upgrades.

AUT.002667 Ōpononi WWTP

To undertake activities associated with the operation of a wastewater treatment system that services the township of Ōpononi.

Condition 21

The Consent Holder shall hold a meeting with the liaison group not less than once every year to discuss matters related to these consents.

·     Pakanae

·     Kokohuia

·     Waiwhatawhata

·     Waimamaku Marae (Ngā Marae O Te Wahapū)

·     Te Rūnanga O Te Rarawa

·     duly appointed representative from each of the Ōmāpere and Ōpononi communities

Previous compliance advisor shared data about the WWTP with community representatives however liaison group has not been established.

Compliance advisor to be recruited for and highlighted as a high priority and to work to get working groups established for compliance purposes.

AUT.0004111 Kerikeri WWTP Discharge

To undertake activities associated with the operation of the Kerikeri WWTP.

Condition 18

The Consent Holder shall organise and convene a Liaison Group for the purposes of facilitating information about compliance with the conditions of this consent and general matters relating to it.

The Liaison Group shall consist of at least one representative from:

·     the Consent Holder;

·     the Northland Regional Council;

·     the Department of Conservation;

·     Ngāti Rēhia;

·     The Otahuao Burial Trust;

·     Te Uri Taniwha; and

·     Ngāti Pou

Representatives were engaged with for the consent variation to increase the discharge from 1,000 m3 to 1,350m3 (average dry weather flow).

Attempts have been made in the past to organise and convene a Liaison Group however a lack of responses to date has meant the group has not been stood up.  Confirmation of the group not being desired will also meet consent conditions.

Compliance advisor to be recruited for and highlighted as a high priority and to work to get working groups established for compliance purposes.

AUT.004369 - Ōpononi Ōmāpere Water Treatment Plant (WTP) - Intake from Waiotemarama Stream

To undertake activities associated with a public water supply servicing the township of Ōmāpere and Ōpononi.

Condition 14

The Consent Holder shall, for the purpose of discussing matters relating to this consent, form a community liaison group. The Consent Holder shall hold a meeting with the liaison group not less than once every year to discuss matters related to these consents. The meeting shall only be held if a representative(s) of the community liaison group request a meeting with the Consent Holder. If such a request is made, then the Consent Holder shall organise a meeting at a local venue for members of the community liaison group to attend and invite all other representatives of the community liaison group. The meeting shall be held at a time convenient for the majority of the community liaison group.

Consisting of representatives from:

·     Pakanae,

·     Kokohuia,

·     Waiwhatawhata and

·     Waimamaku Marae (Ngā Marae O Te Wahapu)

Previous compliance advisor shared data about the WWTP with community representatives however liaison group has not been established.

New Compliance advisor currently getting working groups established for compliance purposes.

AUT.007356.01.02 Ōpononi Ōmāpere WTP - intake from Waiarohia Stream Dam

To undertake activities associated with a public water supply servicing the township of Ōmāpere and Ōpononi.

Condition 20

The Consent Holder shall, for the purpose of discussing matters relating to this consent, form a community liaison group…

Consisting of representatives from:

·     Pakanae,

·     Kokohuia,

·     Waiwhatawhata and Waimamaku Marae (Ngā marae o te Wahapū), and

·     A duly appointed representative from each of the Ōmāpere, Ōpononi and Waiotemarama communities.

Previous compliance advisor shared data about the WWTP with community representatives however liaison group has not been established.

New Compliance advisor currently getting working groups established for compliance purposes.

AUT.005112 - Kaitāia WTP Intake - Awanui River

Take water from the Awanui River for water supply purposes of Kaitāia township and surrounding areas.

Condition 10

The Consent Holder shall establish, convene, maintain and provide reasonable administrative support for an lwi Liaison Group consisting of representatives of Māori groups whose rohe includes the Consent Holder's water abstraction point in the Awanui River. The role of the lwi Liaison Group will be to discuss matters related to these consents, including the results of any monitoring

Initially the Iwi Liaison Group need only include Ngāti Kahu and Te Rūnanga o Te Rarawa.

However, if other Māori groups wish to join the lwi Liaison Group then they may do so by advising the Consent Holder. The role of the lwi Liaison Group will be to discuss matters related to these consents, including the results of any monitoring

In 2019, FNDC staff recorded that a community liaison group meeting was requested but no attendance confirmed so meeting was cancelled, and NRC were advised.

New Compliance advisor currently getting working groups established for compliance purposes.

Condition 11

The Consent Holder shall give written notice of an lwi Liaison Group meeting not less than once annually…

AUT.002041.01.03 Take water from the Petaka Stream

Take water from the Petaka Stream.

Condition 30

The Consent Holder shall establish, convene, maintain and provide reasonable administrative support for a liaison group….. The Consent Holder shall hold a meeting of the liaison group at least one month before the commencement of the construction of the water treatment plant and then not less than once every three months thereafter. The frequency of the meetings can be changed with agreement

Representatives of

·     Ngāti Kaharau and

·     Ngāti Hau Ngā Hapū o Omanaia and

·     the Consent Holder

Attempts have been made by staff however, group has yet to be established

New Compliance advisor currently getting working groups established for compliance purposes.

AUT.001862.01.04 Monument Hill Water Take Kaikohe drinking water

 To take water from two bores (Monument Hill).

Condition 10

…The consent shall hold a meeting… not less than once every 3  months to discuss the report prepared in accordance with condition 9 and any other relevant matters. The meeting shall be held at a time convenient for the majority of the Waikotihe Māori Reservation Trustees

Waikotihe Māori Reservation Trust and the Consent Holder

Attempts have been made by staff however, group has yet to be established

New Compliance advisor currently getting working groups established for compliance purposes.

Condition 14

Unless otherwise agreed by the Waikotihe Trust, the Consent Holder must offer to hold a meeting with the Waikotihe Trustees each year to discuss the report prepared in accordance with Condition 14 and any other relevant matters related to the consent. A meeting must be held at a time convenient for the majority of the Trustees. A record of the minutes of each meeting must be kept and provided to the Trust in advance of the next meeting. A copy of the minutes for each meeting shall be provided to the Northland Regional Councils€™s assigned monitoring officer within 1 month of the meeting being held.

AUT.002041.01.03 and AUT.002041.06.01 Ōmanaia Rāwene Water Treatment Plant

To undertake activities associated with the supply of potable water to Rāwene and Ōmanaia.

Condition 30

The Consent Holder shall establish, convene, maintain and provide reasonable administrative support for a liaison group consisting of representatives. The Consent Holder shall hold a meeting of the liaison group at least one month before the commencement of the construction of the water treatment plant and then not less than once every three months thereafter. The frequency of the meetings can be changed with agreement of the Consent Holder, Ngāti Kaharau, and Ngāti Hau Ngā hapū o Ōmanaia.

Representatives of:

·     Ngāti Kaharau and

·     Ngāti Hau ngā hapū o Ōmanaia and

·     the Consent Holder

Yet to be established

New Compliance advisor currently getting working groups established for compliance purposes.

AUT.001168 Kawakawa WWTP

To undertake activities associated with the operation of wastewater treatment system located at Kawakawa.

Condition 19

The Consent Holder shall hold a meeting with representatives of Ngāti Hine and Ngāti Manu not less than once every year to discuss the report(s) prepared in accordance with Condition 18 and any other relevant matters related to the exercise of these consents. The meeting shall only be held if a representative(s) of Ngāti Hine and/or Ngāti Manu request a meeting with the Consent Holder. If such a request is made, then the Consent Holder shall organise a meeting at a local venue for the representative(s) of Ngāti Hine and Ngāti Manu to attend. The meeting shall be held at a time agreed with the representative(s) of Ngāti Hine and Ngāti Manu

·     Ngāti Hine

·     Ngāti Manu

No record of information being shared with Ngāti Hine and Ngāti Manu.

New Compliance advisor currently getting working groups established for compliance purposes.

Ordinary Te Koukou - Transport and Infrastructure Committee  Meeting Agenda

25 February 2025

Next steps:

·    Quarterly reporting to Te Koukou is proposed, with the next update due February 2025.

·    In the next update to include working groups that have not been set up and have resulted in non-compliances.

PĀNGA PŪTEA ME NGĀ WĀHANGA TAHUA / Financial Implications and Budgetary Provision

There are no financial or budgetary implications arising from this report.

Āpitihanga / Attachments

Nil

Te Koukou - Transport and Infrastructure Committee Meeting Agenda

25 February 2025

6.5         Infrastructure Consenting Status Report

File Number:           A5046620

Author:                    Simone Elsmore, Infrastructure Consenting Team Leader

Authoriser:             Tanya Proctor, Head of Infrastructure

TAKE PŪRONGO / Purpose of the Report

This report provides an overview and status update of the current Infrastructure Consenting work programme.

WHAKARĀPOPOTO MATUA / Executive SummarY

Te Kaunihera o Te Hiku o Te Ika – Far North District Council holds a substantial number of resource consents, issued under the provision of the Resource Management Act 1991, for the construction and operation of Water, Wastewater, Stormwater and District Facility infrastructure assets. These consents require an ongoing programme of work to ensure the timely renewal of consents nearing expiry, and the application for new consents required through changing legislative requirements or for the construction of new infrastructure.

Progress update highlights from the status report presented to the November 2024 meeting of Te Koukou include:

·    Ōpononi/Ōmāpere Wastewater Treatment Plant - consent renewal: The Environment Court issued its decision to grant Far North District Council’s resource consent application on 19th November 2024.

·    Solid Waste consents: Solid Waste consents have been added to this update report and are included in Table 1: 3Waters and District Facilities Consent Renewal Work Programme.

·    Houhora Campground Wastewater Disposal System - new consent: A resource consent application for the wastewater disposal system was lodged with Northland Regional Council in December 2024.

·    Kāeo Wastewater Treatment Plant – consent renewal: Expected submission for additional information was planned for December 2024. However, more engagement with tangata whenua is required. Submission to Northland Regional Council is now expected for June 2025.

Future reporting to Te Koukou Committee will be bi-monthly with the next report scheduled for the April 2025 committee meeting.

 TŪTOHUNGA / Recommendation

That Te Koukou - Transport and Infrastructure Committee receive the report Infrastructure Consenting Status Report.

tĀHUHU KŌRERO / Background

Information reports are provided to each Te Koukou Committee meeting commencing to provide updates on the ongoing programme of work to ensure the timely renewal of consents nearing expiry, and the application for new consents required through changing legislative requirements or for the construction of new infrastructure.

Previous reports focussed on Water, Wastewater and Stormwater consent activity. This has now been extended to include the District Facilities activities, which includes Solid Waste.

MATAPAKI ME NGĀ KŌWHIRINGA / Discussion and Next Steps

Table 1 summarises the LTP 24/27 consenting work programme, providing an update on progress and the stage these planned works are at.

The key changes since the November 2024 Te Koukou Committee meeting are:

·    Ōpononi/Ōmāpere Wastewater Treatment Plant Consent – The Environment Court issued its decision to grant FNDCs resource consent application on, and with effect from, 19th November 2024. The consent is for a period 3 years.

·    District Facilities activity consents – The consent renewal work programme has been updated to include District Facilities, including Solid Waste, consents.

·    Houhora Campground Wastewater Disposal System – A resource consent application for the Wastewater Disposal system was lodged with Northland Regional Council in December 2024.

·    Kāeo Wastewater Treatment Plant Expected submission for additional information was planned for December 2024. However, more engagement with tangata whenua is required. Submission to Northland Regional Council is now planned for June 2025.

In addition to planned consent renewals programme there is additional, unplanned consenting work arising from changes in legislation and Council’s capital works programme. Planning assessments are required to determine the need for a consent prior to preparing consent applications which may be for multiple agencies including Far North District Council, Northland Regional Council and concession permits from the Department of Conservation. The current unplanned works include:

·    Kawakawa Wastewater Treatment Plant Stream Diversion – resource consent Northland Regional Council

·    Marreine Place – concession from Department of Conservation

·    Tokerau Beach Storage Tank – concession from Department of Conservation

·    Tokerau Beach Storage Tank - resource consents from Far North District Council and Northland Regional Council

There is continuous focus on workload planning and early engagement to ensure consents are lodged a minimum of six months prior to the expiration of a consent, to reduce and ultimately eliminate any assets operating on expired consents.

Future Reporting

This report will be presented to Te Koukou Committee bi-monthly with the next report scheduled for the April 2025 committee meeting.

Table 1: 3Waters and District Facilities Consent Renewal Work Programme

Asset (Three Waters/District Facilities)

Expiry Date

Date Application Lodged

Completion status of project

LTP Period

Key milestones

Milestone completion date

Wastewater Treatment Plant Resource Consents

Kaikohe Wastewater Treatment Plant
AUT.002417.01.03

30/11/2021

27/08/2021

60%

FY24/25

Determine next steps

Apr-25

Provide an update to next Te Koukou meeting

Apr-25

Kaitāia Wastewater Treatment Plant
AUT.000932.01.03

30/11/2021

24/08/2021

80%

FY24/25

Redraft proposed consent conditions

Feb-25

Submitters response

Feb-25

Northland Regional Council processing

Mar-25

Next steps determined on NRC processing

TBC

Kāeo Wastewater Treatment Plant
AUT.007205.01.03

31/10/2022

27/07/2022

60%

FY24/25

Procure external expertise

Jan-25

Engage with Tangata Whenua and work on proposed consent conditions

May-25

Submit Addendum application

Jun-25

Public notification

TBC by NRC

Northland Regional Council processing

Dec-25

Hihi Wastewater Treatment Plant
AUT.007399.01.02

30/11/2022

31/08/2022

60%

FY24/25

Commission Cultural Impact Assessment

Feb-25

Engage with tangata whenua and work on proposed consent conditions

Jul-25

Submit addendum application to NRC

Dec-25

Public notification

TBC by NRC

Northland Regional Council processing

Jun-26

Rāwene Wastewater Treatment Plant
AUT.002577.01.03

31/08/2023

27/04/2023

60%

FY24/25

Determine next steps

Apr-25

Provide an update to next Te Koukou update

Apr-25

Kororāreka/Russell Wastewater Treatment Plant
AUT.008339.01.03

30/04/2024

19/12/2023

70%

FY24/25

Procure external expertise

Jan-25

Submit addendum application

Mar-25

Public notification

TBC by NRC

Northland Regional Council processing

Dec-25

Whatuwhiwhi Wastewater Treatment Plant
AUT.007205.02.02

30/11/2025

-

30%

FY24/25

Lodge application

May-25

Public notification

TBC by NRC

Northland Regional Council processing

Dec-25

Ōpononi & Omāpere Wastewater Treatment Plant
AUT.002667.01.03

19/11/2027

-

0%

FY26/27

Preparatory work to begin May 2026 to determine next steps

June 2026

Water Treatment Plant Resource Consents

Kaikohe – Wairoro Stream
AUT.004109.01.03

31/05/2026

-

5%

FY25/26

Concept and feasibility

Mar-25

Prepare and lodge application

Oct-25

Northland Regional Council processing

Jun-26

Ōpononi/Omāpere Waiotemarama Stream Dam
AUT.004369.01.03

31/08/2026

-

5%

FY25/26

Concept and feasibility

Mar-25

Prepare and lodge application

Oct-25

Northland Regional Council processing

Jun-26

Ōpononi/Omāpere Waiarohia Stream Dam
AUT.007356

31/08/2026

-

5%

FY25/26

Concept and feasibility

Mar-25

Prepare and lodge application

Oct-25

Northland Regional Council processing

Jun-26

Kaikohe – Monument Hill and Squires Springs
AUT.001862.01 & 02.04

31/05/2027

-

0%

FY26/27

Preparatory work to begin May 2025 to determine next steps

June 2025

Stormwater Resource Consents

Kerikeri Stormwater discharge
AUT.004835.01.02

31/03/2012

4/10/2011

70%

FY24/25

Submit addendum application

Feb-25

Northland Regional Council processing

Jul-25

Kaitāia Stormwater discharge

NEW

-

30%

FY24/25

Concept and feasibility

Mar-25

Prepare and lodge application

Oct-25

Northland Regional Council processing

Jun-26

District Facilities Resource Consents

Kaitāia Refuse Transfer Station Consent
AUT.019502.01.01

30/11/2023

29/08/2023

60%

FY24/25

Determine next steps

Apr-25

Provide an update to next Te Koukou update

Apr-25

Houhora Campground
AUT.007711.01.02

30/11/2025

11/12/2024

80%

FY24/25

Application lodged - complete

Complete

Northland Regional Council processing

Jun-25

Tauranga Bay Campground
AUT.004237.01.03

30/11/2025

-

20%

FY24/25

Concept and feasibility

Mar-25

Prepare and lodge application

May-25

Northland Regional Council processing

Aug-25

Kaikohe Closed Landfill Consent
AUT.007503.01.01

31/09/2025

-

5%

FY24/25

Procure external expertise

Feb-25

Prepare and lodge application

May-25

Northland Regional Council processing

Aug-25

Totara North Closed Landfill Consent

31/10/2026

-

0%

FY25/26

Allocate to FNDC staff

Mar-25

Prepare and lodge application

May-26

Russell Landfill Closed Landfill consent

30/06/2028

-

40%

Better off funding

Engagement with tangata whenua

TBC with Tangata Whenua

Prepare and lodge application

Dependant on engagement

Taipa Refuse Transfer Station Consent
APP.045333.01.01

NEW

29/08/2023

60%

FY24/25

Engagement with tangata whenua on cultural impact assessment

TBC with Tangata Whenua

Submit additional work to Northland Regional Council

Dependant on engagement

Northland Regional Council processing

Dependant on engagement

Ordinary Te Koukou - Transport and Infrastructure Committee Meeting Agenda

25 February 2025

PĀNGA PŪTEA ME NGĀ WĀHANGA TAHUA / Financial Implications and Budgetary Provision

There are no financial implications or budgetary provision arising from this report.

Āpitihanga / Attachments

Nil

Ordinary Te Koukou - Transport and Infrastructure Committee Meeting Agenda

25 February 2025

6.6         Capital Works Programme Delivery Update

File Number:           A5066245

Author:                    Sharon Ryan, Projects Analyst

Authoriser:             Tanya Proctor, Head of Infrastructure

TAKE PŪRONGO / Purpose of the Report

The purpose of the report is to demonstrate the progress made on the delivery of the Capital Works Programme for FY25 including FY24 Carry Forwards.  Progress reported is to 31 December 2024.

WHAKARĀPOPOTO MATUA / Executive SummarY

·    The Capital Programme for Year 1 of LTP 24/27 excluding Roading, Solid Waste, Unplanned/Reactive Works, and Resource Consenting totals $51.3m for a total of 67 discrete physical works projects, 18 of which are planned to be delivered over multiple financial years.

·    The FY24 Carry Forward programme also excluding Roading, Solid Waste, Unplanned/Reactive Works, and Resource Consenting totals $28.2m for a total of 121 discrete physical works projects, 12 of which are planned to be delivered over multiple financial years.

·    Significant progress has been made in completing FY24 Carry Forward projects and progressing FY25 physical works projects into Design and Delivery.

·    A projection of FY25 Carry Forward budgets is $41.1m of which wastewater project budgets make up 49%. There are six discrete projects making up 84% of the wastewater carry forward budget lines and these are either in Construction or Design or are linked to planned multi-year projects.

 TŪTOHUNGA / Recommendation

That the Te Koukou - Transport and Infrastructure Committee receive the report Capital Works Programme Delivery Update.

tĀHUHU KŌRERO / Background

The Long-Term Plan 2024/2027 (the LTP) is an LTP Lite. It includes a capital works programme of projects that must meet one or more of the following criteria: Roading, Storm Recovery, or Compliance.

The timing of capital budgets reflects the delivery of physical works and so some capital projects have budgets that span more than a single financial year. The tables below refer to these as multi-year projects.

Note: The impact of multi-year project budget timing is that a rating impact (interest and depreciation charges) is triggered in the financial year following completion of the physical works.

A summary of the LTP Year 1 (FY25) Capital Programme excluding Roading, Solid Waste, Unplanned/Reactive Works, and Resource Consenting, is shown in the following table.

Year 1 Programme

Projects

(total in number)

Projects by value

$

Multi-year projects

(total in number)

District Facilities

19

10,094,237

2

Stormwater

10

9,802,195

2

Water

15

8,821,858

4

Wastewater

23

22,612,985

10

Totals

67

51,331,275

18

Unspent capital funds, required to meet the cost to complete projects in progress at 30 June 2024, have been approved as FY24 Carry Forward capital works.

Note: budgets for projects that appear as both FY24 Carry Forward and FY25 are kept separate, however they are included as project numbers in both tables.

A summary of the FY24 Carry Forward capital works, excluding Roading, Solid Waste, Unplanned/ Reactive Works, and Resource Consenting, is shown in the following table:

 FY24 Carry Forwards

Projects

(total in number)

Projects by value

$

Multi-year projects

(total in number)

District Facilities

45

10,424,503

4

Stormwater

9

1,958,156

1

Water

30

4,348,818

2

Wastewater

37

11,511,840

5

Totals

121

28,243,317

12

MATAPAKI ME NGĀ KŌWHIRINGA / Discussion and Next Steps

FY25 Capital Programme Delivery Update

The FY25 Capital Works Programme for District Facilities, Stormwater, Water, and Wastewater activities is the combined total of capital budgets from Year 1 of the LTP 24/27 plus approved FY24 Carry Forward budgets.

For physical works, the total funding of the Programme is divided into three categories - LTP, Carry Forward, and Unplanned/Reactive.

Delivery of the programme is separated by Activity using the Project Management Framework stages as the Project Status. These are:

·    Concept

·    Design & Planning

·    Procurement

·    Construction

·    Completion

Resource Consent projects have been separated from physical works and are reported by Activity.

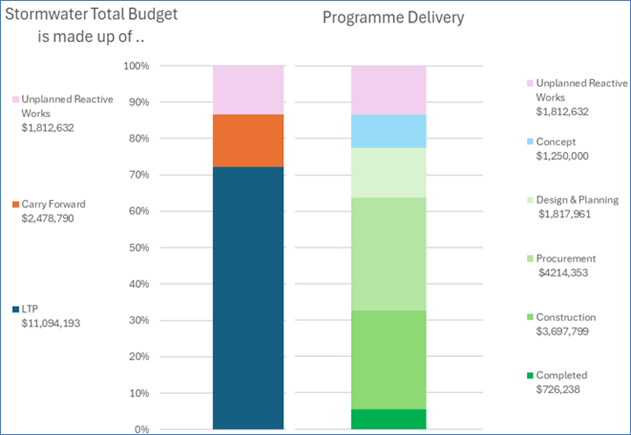

The graphs below demonstrate current progress to December 2024 in the delivery of the FY25 Capital Programme by comparing total funding with project status.

A screenshot of a graph

Description automatically generated

Highlights:

·    Eight projects have been completed within budget by $5k, all are FY24 Carry Forward projects

·    Concept status has just one project – Kaitāia Airport Runway

·    Two maritime projects led by Far North Holdings Ltd make up 61% of projects in Design & Planning

·    All projects currently in Procurement are expected to be complete by June 2025

·    All but one project currently in Construction are expected to be complete by June 2025

·    Unplanned/Reactive works are comprised of Community Board delegation budgets.

A graph of a budget

Description automatically generated with medium confidence

Highlights:

·    Four projects have been completed within budget by $586k, 3 are FY24 Carry Forward projects

·    Concept status has just one project – Allen Bell Drive, Kaitāia (pipe renewal). This is expected to be in Procurement by June 2025

·    All three projects in Planning and Design will still be in progress by June 2025, either in Construction or Procurement. All of these are multi-year projects

·    Two of the three projects in Procurement are expected to be complete by June 2025 with the remaining project in Construction

·    One of the two projects in Construction is expected to be complete by June 2025 with the remaining project expected to be complete by August 2025

·    Unplanned/Reactive works budgets are to meet unspecified reactive works.

A graph of a budget

Description automatically generated with medium confidence

Highlights:

·    15 projects have been completed within budget by a net total of $205k, 14 are FY24 Carry Forward projects

·    No projects are in Concept

·    One project in Design and Planning is expected to be complete by June 2025. The remaining 11 projects will still be in this stage due to being multi-year projects such as Paihia Water Treatment Plant, or delivery delayed such as Fluoridation, or are part of multi-year programmes such as Water Safety Plan Requirements

·    One project in Procurement is expected to be complete by June 2025 with the remaining projects in Construction

·    Nine projects in Construction are all expected to be complete by June 2025.

A graph of a budget

Description automatically generated with medium confidence

Highlights:

·    17 projects have been completed within budget by a net total of $621k, 16 are FY24 Carry Forward projects

·    Of the ten projects in Concept, one is expected to be complete, three in Construction and the remainder in Design and Planning by June 2025. Five of these projects are multi-year projects with one linked to a wider IAF project (Kaikohe)

·    Two of the four projects in Design and Planning are expected to be complete or in Construction by June 2025. The remaining two projects are multi-year projects

·    Three of the six projects in Procurement are expected to be complete with the remaining three in Construction by June 2025

·    Five of the 12 projects in Construction are expected to be complete with the remaining seven nearing completion by June 2025

Resource Consents

A graph of water and water

Description automatically generated

A separate report providing an overview and status update of the current Infrastructure Consenting work programme is included in this meeting agenda – Infrastructure Consenting Status Report.

Year End Forecast

A projection of the FY25 Capital Programme budgets is provided in the table below. This projection will be updated in each future report to Te Koukou.

Completed Projects $000

Construction $000

Procurement $000

Design
$000

Forecast FY25

Carry Forwards

$000

District Facilities

9,050

7,051

855

3,563

9,073

Storm Water

3,815

6,499

1,447

4,722

Water

5,530

900

354

6,387

6,889

Wastewater

7,538

17,208

3,905

5,473

20,472

Totals

25,933

31,658

6,561

15,423

41,156

Wastewater is the significant contributor to FY25 Carry Forwards and the total above includes the following projects:

·    Kaikohe network and treatment plant $3.2m linked to multi-year IAF projects (in Design)

·    Kaitāia network overflows $5m (in Construction)

·    SCADA Telemetry multi-year project $3.5m (in Construction)

·    Ōpononi treatment plant $3.9m (in Construction)

·    Paihia PS1 upgrade $1.6m (in Construction)

PĀNGA PŪTEA ME NGĀ WĀHANGA TAHUA / Financial Implications and Budgetary Provision

This is an information report and as such does not have any direct financial implications or budgetary provision.

Āpitihanga / Attachments

Nil

Ordinary Te Koukou - Transport and Infrastructure Committee Meeting Agenda

25 February 2025

6.7         Road Safety Education and Engineering Update

File Number:           A5066331

Author:                    Elizabeth Stacey, Team Leader - Capital Works & Renewals

Authoriser:             Tanya Proctor, Head of Infrastructure

TAKE PŪRONGO / Purpose of the Report

The purpose of this report is to provide an update on the Road Safety Education, Promotion and Engineering activities undertaken in between October and December 2024.

WHAKARĀPOPOTO MATUA / Executive SummarY

Key highlights from the road safety programme for the education, promotion and engineering activities are summarised below:

·    Road safety education and promotion activities delivered by Far North REAP (Rural Education Activities Programme) in December included the Patience to Paradise pop up campaign and deliver of Learner and Restricted/Full Drivers License courses to 130 participants.

·    Additional funding confirmed for Far North REAP’s educational programme at the December Council meeting.

·    Significant decrease in fatal and serious crashes in the October and December reporting period compared to prior year.

·    Increased number of resource consent applications requiring engineering input over the quarter.

·    273 new Corridor Access requests were received for works in the road reserve across the Far North District in October-December.  Work also included coordination with the Waitangi National Trust in preparation for Waitangi Day events.

 TŪTOHUNGA / Recommendation

That Te Koukou - Transport and Infrastructure Committee receive the report Road Safety Education and Engineering Update.

tĀHUHU KŌRERO / Background

The road safety team works across road safety and traffic engineering, road safety education and promotion, engineering input into resource consent applications and approval of Corridor Access requests and the issue of work access permits.

MATAPAKI ME NGĀ KŌWHIRINGA / Discussion and Next Steps

Far North REAP are contracted to deliver Council’s Road Safety and Education programme in the Far North through a series of community based providers.  The following table shows the key initiatives and activities undertaken in December:

Road Initiative Name

Initiatives Total

Number of Participants

Learners Driver Licence Courses

3

50

Restricted/Full Driver Licence Courses

3

80

“Patience to Paradise” Pop Up – Campaign

4

75

Road Safety Social Media Campaign – Focus Points – Distraction, Speed & Restraints

3

5000+ Followers

Road Initiative Name

Initiatives Total

Number of Participants

Hapu Mama / Mama Groups – Restraints & Installation

1

3

Rapu Ora Ladies – Drug & Alcohol Korero

1

25

Rapu Ora Road Safety Message – “Better to be late than dead on time”

1

25

Road Safety Presentation – Ngati Hine Health Trust

2

35

“Driving to be Patient” Presentation

1

80

Rapu Ora Road Safety Meetings (High Risk)

1

40

“Buckle Up Always” – Presentation

1

25

“Seat belts on” – Presentation

1

16

“Better to Arrive Late, Than Dead on Time” – Presentation

1

85

Restraint Installation – Educating Whanau (Oct & Nov)

1

8

Apiti Hono Tatai Hono (Ngāpuhi Road show) Campaign Promo Resources:

“Arrive Alive, Slow Down, One Tear Too Many, Patience to Paradise”

(Oct & Nov)

1

400

Kahu Taurima Team Day Event – Korero around Child restraints, driver licencing & Distraction (Oct)

3

15

Impairment Vision Goggles – Obstacle Course (Oct & Nov)

1

22

Kaumatua & Kuia – RS Presentation

1

10

Key Performance Indicators – Fatal and Serious Crash Reporting

In the December 2024 there was only one reported serious injury crash on FNDC roadways and no fatalities.  This compares to the previous December where we had three fatal and two serious injury crashes on our network, representing a significant decrease.

For the second quarter, there was a reduction of 8 fatal and serious injury crashes in 2024 compared to the same quarter in the previous year.

Measures

Oct-24

Nov-24

Dec-24

Q2 Total Fatal & Serious Crashes

Fatalities/serious injury crashes 2024/25

1

3

1

5

Fatalities/serious injury crashes 2023/24

5

3

5

13

Variance

-4

0

-4

-8

Engineering Input into Resource Consents

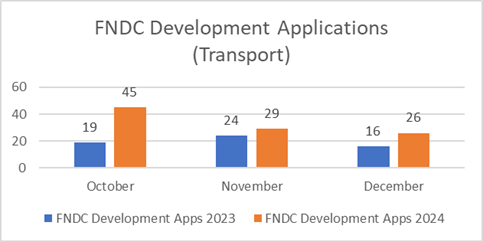

The number of resource consents received in October-December this year (2024) in orange compared to the same time period in 2023 in blue.

A graph of a number of applications

Description automatically generated with medium confidence

Resource consents are required for a multitude of activities where traffic engineering input could be required (e.g., forestry works, commercial activities, and more). However, majority of the consents received this year are related to residential developments. The number of resource consents received this year has grown a significant amount when compared to last year. This could be a response to a rebounding development/construction market, or the introduction of fast-track applications.

Corridor Access Requests (CAR)

There were 273 Corridor Access applications received in the months of October - December for works in the road reserve and 159 Work Access Permits granted.    Staff are working with the Waitangi National Trust, NZ Police and other stakeholders finalising traffic control plans for Waitangi Day.

A graph of different colored bars

Description automatically generated

PĀNGA PŪTEA ME NGĀ WĀHANGA TAHUA / Financial Implications and Budgetary Provision

Far North REAP’s road safety education programme is subsidised by NZTA at the 71% Council Financial Assistance Rate.  An additional $1,063,430 in local share will be programmed over the three year period per Council Resoltuion 2024/172.

Āpitihanga / Attachments

Nil

Ordinary Te Koukou - Transport and Infrastructure Committee Meeting Agenda

25 February 2025

6.8         Transport Capital Works Programme Update

File Number:           A5066461

Author:                    Elizabeth Stacey, Team Leader - Capital Works & Renewals

Authoriser:             Tanya Proctor, Head of Infrastructure

TAKE PŪRONGO / Purpose of the Report

Provide an update to elected members on the status of the 2024-2027 Transportation Capital Works and Renewals Programme.

WHAKARĀPOPOTO MATUA / Executive SummarY

The Transport Capital Works & Renewals Programme Report for the month ending January 2025 includes the following key progress:

•        Approval for establishment of a Contractor Panel will be presented to the 13th February Council meeting.

•        Whangae Road slip project is complete.

•        West Coast Rd Motuti, and West Coast Rd Panguru slips are now under construction.

•        Ngāpipito Road repair works beginning in February.

•        Internal project management resources have increased to support the capital delivery programme.

 TŪTOHUNGA / Recommendation

That Te Koukou - Transport and Infrastructure Committee receive the report Transport Capital Works Programme Update.

tĀHUHU KŌRERO / Background

The Transport Capital Works and Renewals Team is responsible for delivery of the following programmes:

·    Bridge Resilience

·    Footpath (new works)

·    Resilience programme

·    Emergency Works/Slip Repair

·    Pavement reseal and rehabilitation

·    Low Cost Low Risk programme

MATAPAKI ME NGĀ KŌWHIRINGA / Discussion and Next Steps

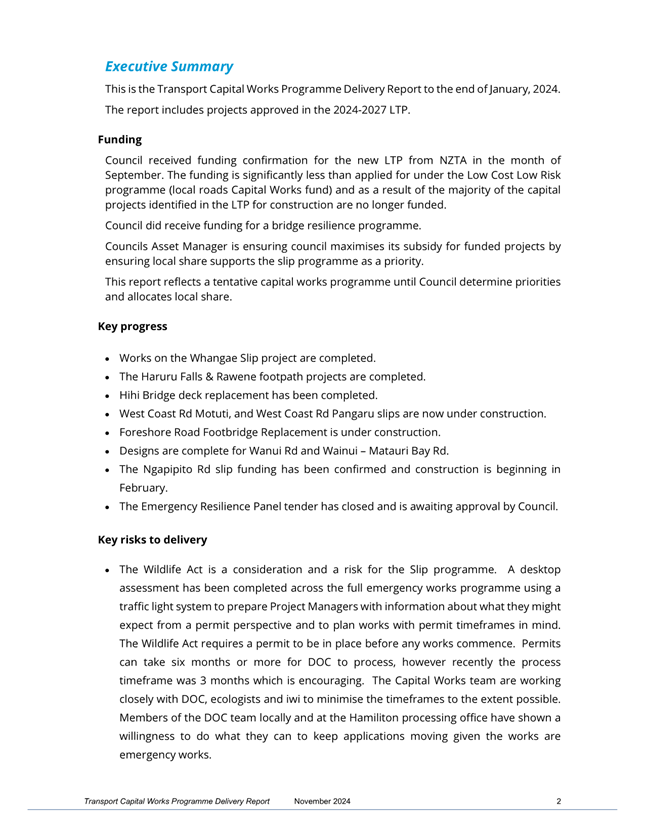

The January 2025 Transport Capital works reports documents the progress of our capital programme and is attached for information.

PĀNGA PŪTEA ME NGĀ WĀHANGA TAHUA / Financial Implications and Budgetary Provision

There are no changes to the existing budgets.  All project budgets are approved in the current Long Term Plan.

Āpitihanga / Attachments

1.       Te Koukou January 25Capital Works update - A5069363

Ordinary Te Koukou - Transport and Infrastructure Committee Meeting Agenda

25 February 2025

A screenshot of a document

AI-generated content may be incorrect.

A close-up of a document

AI-generated content may be incorrect.

A screen shot of a document

AI-generated content may be incorrect.

A screenshot of a computer screen

AI-generated content may be incorrect.

A screenshot of a document

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A screenshot of a document

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

Ordinary Te Koukou - Transport and Infrastructure Committee Meeting Agenda

25 February 2025

6.9         North Hokianga Working Group Roading Update

File Number:           A5067913

Author:                    Apikali Rokobigi, Maintenance Lead

Authoriser:             Tanya Proctor, Head of Infrastructure

TAKE PŪRONGO / Purpose of the Report

The purpose of this report is to present the North Hokianga Roading update report on the progress with approved transportation programmes and completed roading maintenance activities for December 2024 and January 2025 are attached for Committee information.

WHAKARĀPOPOTO MATUA / Executive SummarY

·         At a public meeting held at Te Kura Taumata ō Panguru on Sunday 5th May 2024, it was agreed that a Working Group be established.

·         This report seeks to update Te Koukou Transport and Infrastructure Committee in regard to the establishment of the North Hokianga Roading Working Group.

 TŪTOHUNGA / Recommendation

That Te Koukou - Transport and Infrastructure Committee receive the report North Hokianga Working Group Roading Update.

tĀHUHU KŌRERO / Background

The North Hokianga Working Group is a Working Group of the Far North District Council formally established to address various issues raised by Mana Whenua of North Hokianga.

The aim of this strength-based partnership between Council and the Takiwā to improve roading conditions in the North Hokianga.

MATAPAKI ME NGĀ KŌWHIRINGA / Discussion and Next Steps

The North Hokianga roading update is for information only.

PĀNGA PŪTEA ME NGĀ WĀHANGA TAHUA / Financial Implications and Budgetary Provision

The works carried out in the North Hokianga is included in the 2024-27 Long Term Plan.

Āpitihanga / Attachments

1.       Roading Update for North Hokianga Meeting February 2025 - A5073939

Ordinary Te Koukou - Transport and Infrastructure Committee  Meeting Agenda

25 February 2025

A screenshot of a computer

AI-generated content may be incorrect.

A close-up of a document

AI-generated content may be incorrect.

A screenshot of a phone number

AI-generated content may be incorrect.

A white sheet with black text

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A white sheet with black text

AI-generated content may be incorrect.

A white sheet with black text

AI-generated content may be incorrect.

A white sheet with black text

AI-generated content may be incorrect.

A white and blue text on a white background

AI-generated content may be incorrect.

A close-up of a document

AI-generated content may be incorrect.

A table of food items

AI-generated content may be incorrect.

A screenshot of a computer screen

AI-generated content may be incorrect.

Ordinary Te Koukou - Transport and Infrastructure Committee Meeting Agenda

25 February 2025

6.10       Transportation Maintenance and Renewals Activity Update December 2024

File Number:           A5058099

Author:                    Apikali Rokobigi, Maintenance Lead

Authoriser:             Tanya Proctor, Head of Infrastructure

TAKE PŪRONGO / Purpose of the Report

The purpose of this briefing is to present the December 2024 Transportation Maintenance and Renewals activity monthly reports, as an update on progress with approved transportation programmes and activities, for committee review, discussion and questions.

WHAKARĀPOPOTO MATUA / Executive SummarY

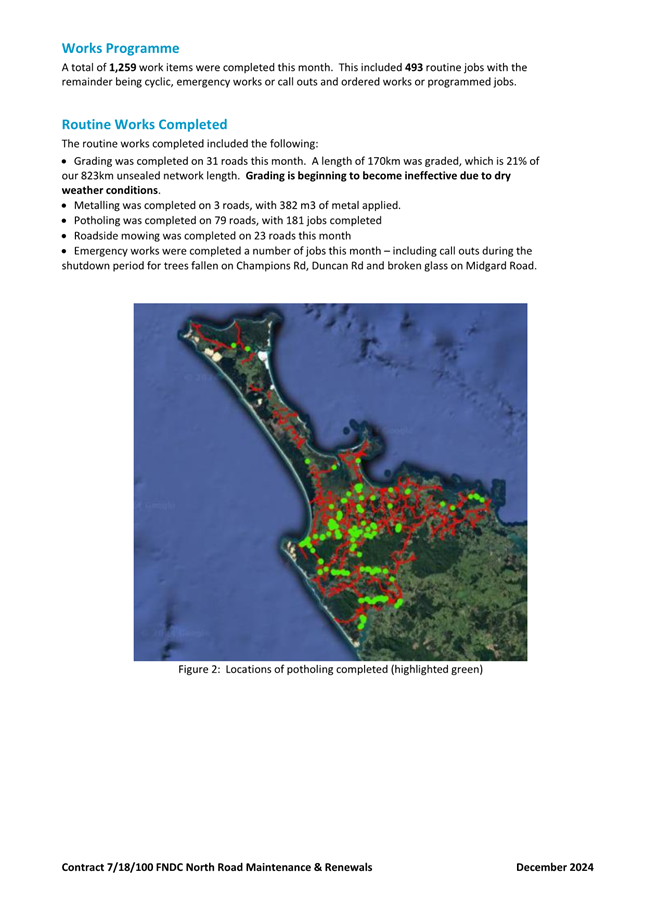

·        Activity reports from contractors for roading and transportation are attached.

·        The reports are intended to provide insight into operational activity completed within the month.

 TŪTOHUNGA / Recommendation

That Te Koukou - Transport and Infrastructure Committee receive the report Transportation Maintenance and Renewals Activity Update December 2024.

tĀHUHU KŌRERO / Background

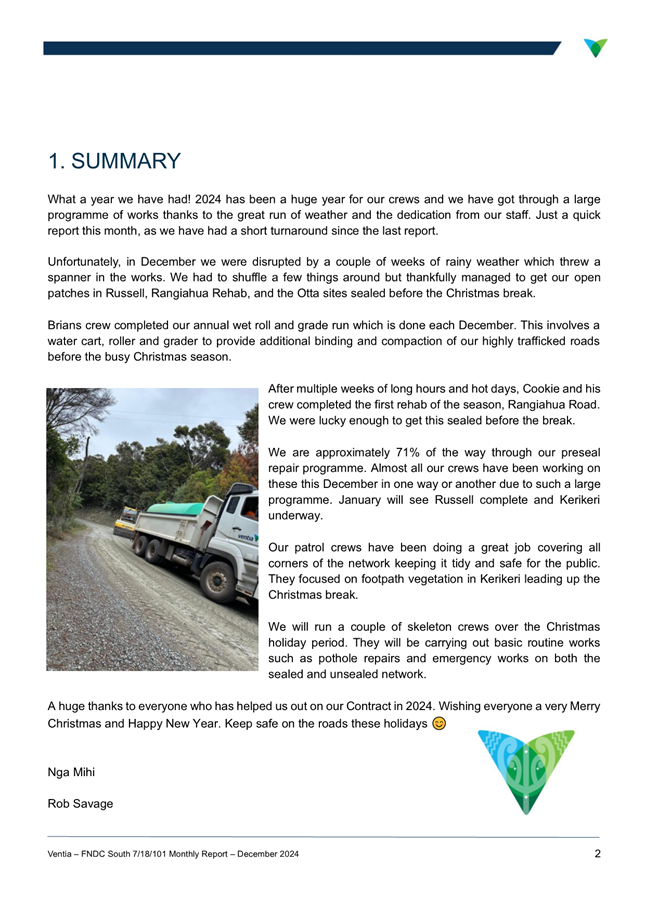

Each month Council’s two main roading contractors – Fulton Hogan and Ventia provide updates on works undertaken. The two attachments report on the works undertaken through the month of December 2024.

These reports are published on our Council website for public information and attached to this report for governance oversight.

MATAPAKI ME NGĀ KŌWHIRINGA / Discussion and Next Steps

The monthly reports are for information only.

PĀNGA PŪTEA ME NGĀ WĀHANGA TAHUA / Financial Implications and Budgetary Provision

The financial and budgets is included in a separate report under the Transport Maintenance and Operations Programme Delivery Update

Āpitihanga / Attachments

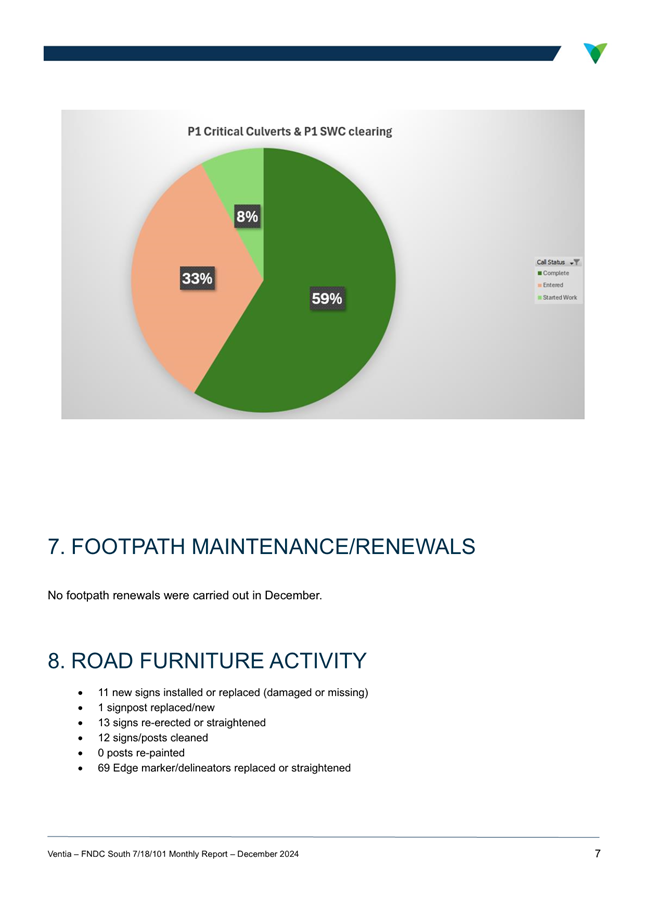

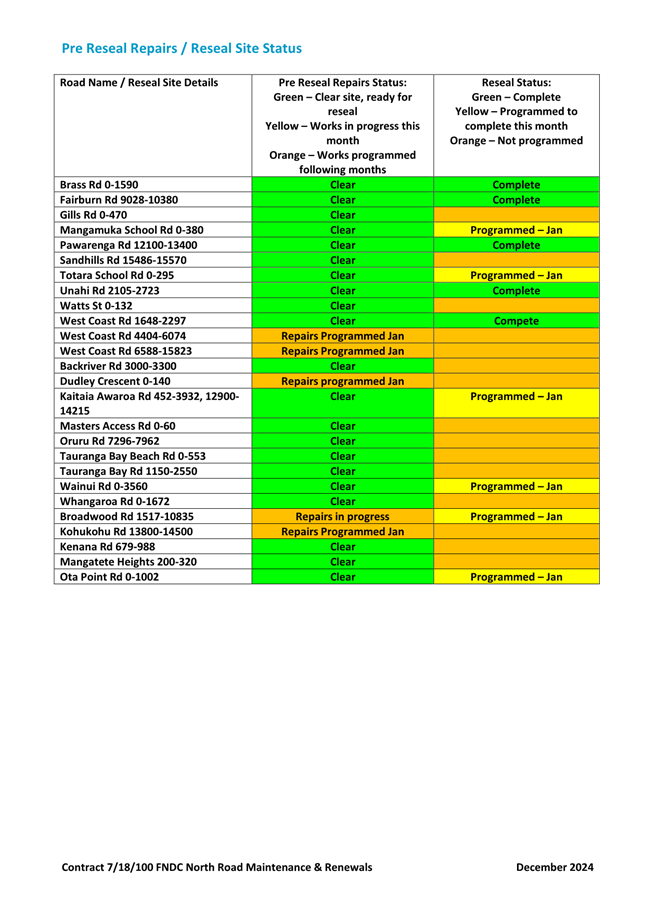

1.       December 2024 Monthly Report 7-18-100 North Contract - A5058066

2.       December 2024 Monthly Report 7-18-101 South Contract - A5058069

Ordinary Te Koukou - Transport and Infrastructure Committee Meeting Agenda

25 February 2025

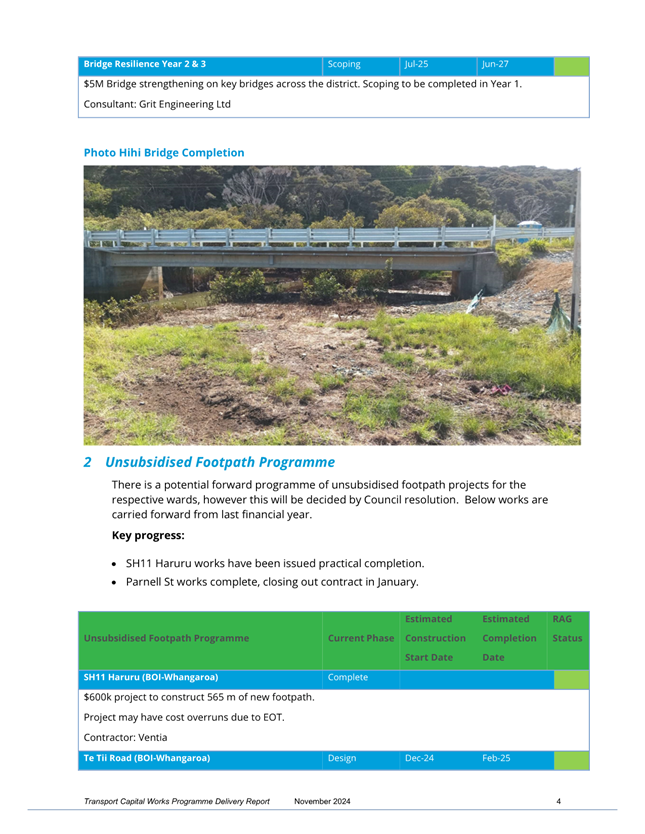

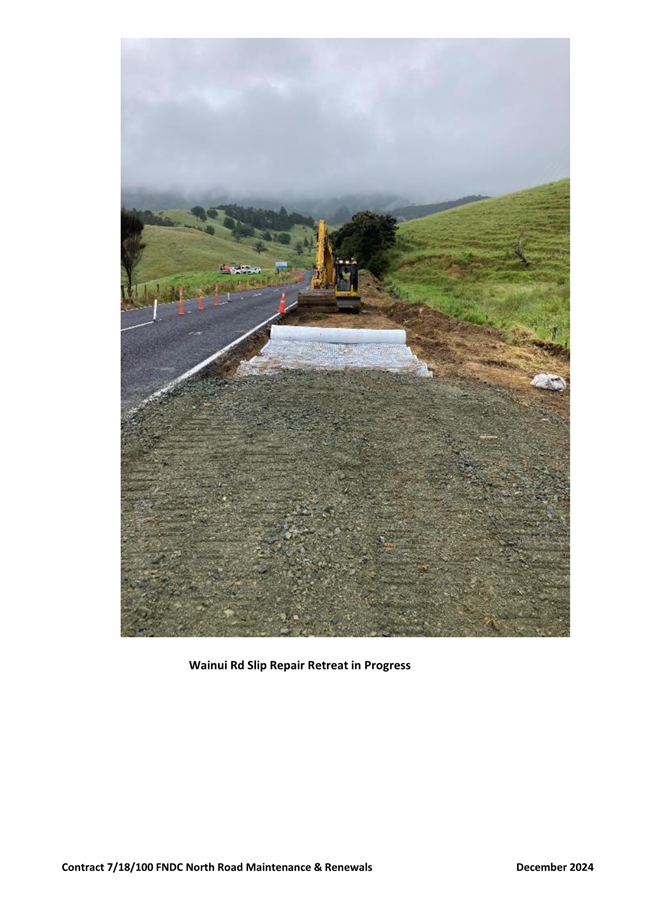

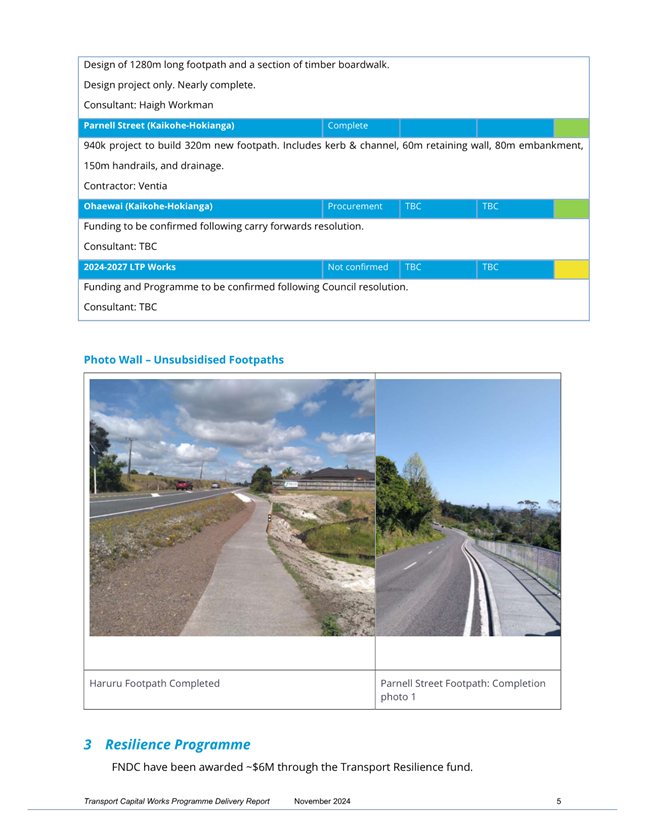

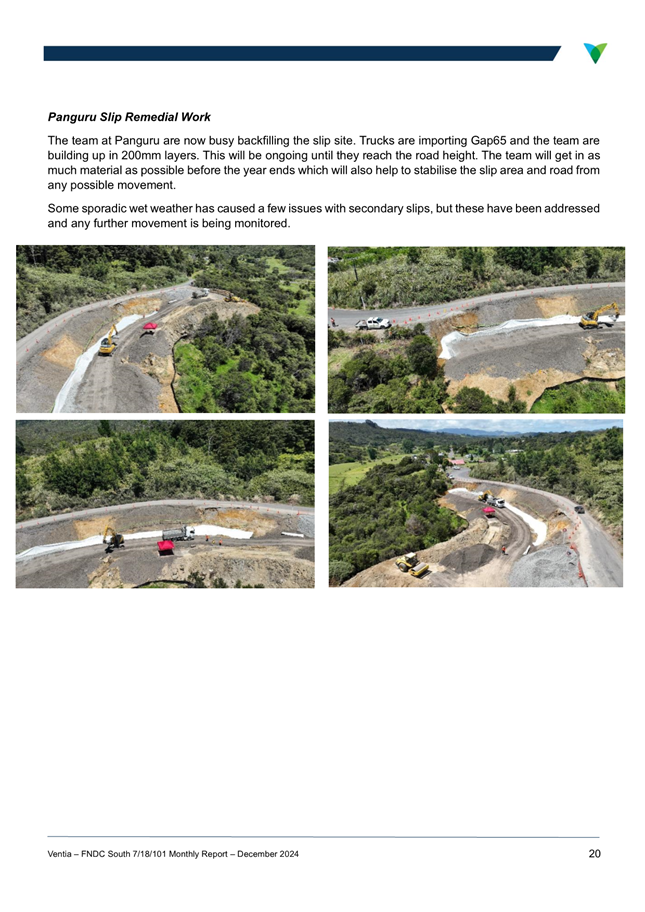

A gravel road with trees in the background

AI-generated content may be incorrect.

A collage of a road

AI-generated content may be incorrect.

A map of a city

AI-generated content may be incorrect.

A screenshot of a satellite image of a map

AI-generated content may be incorrect.

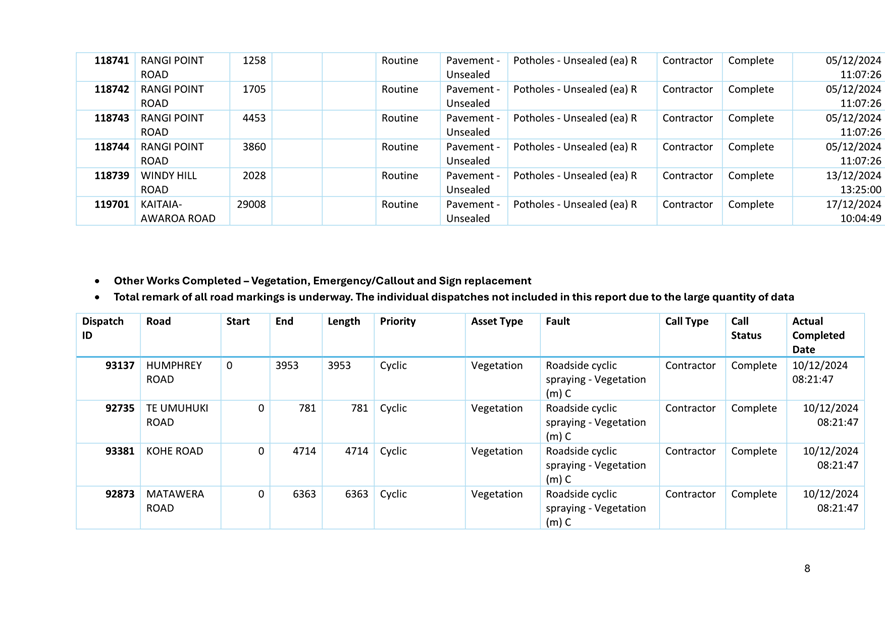

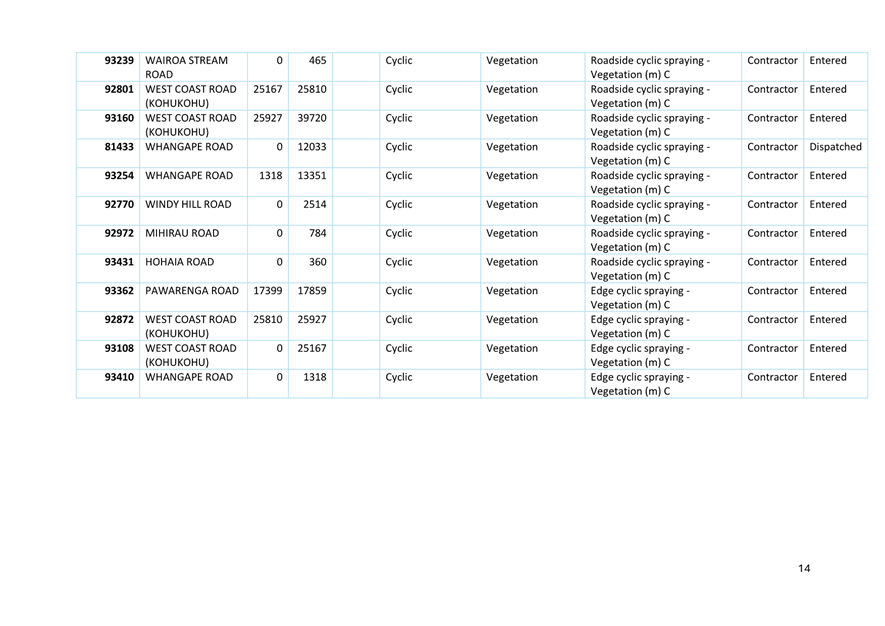

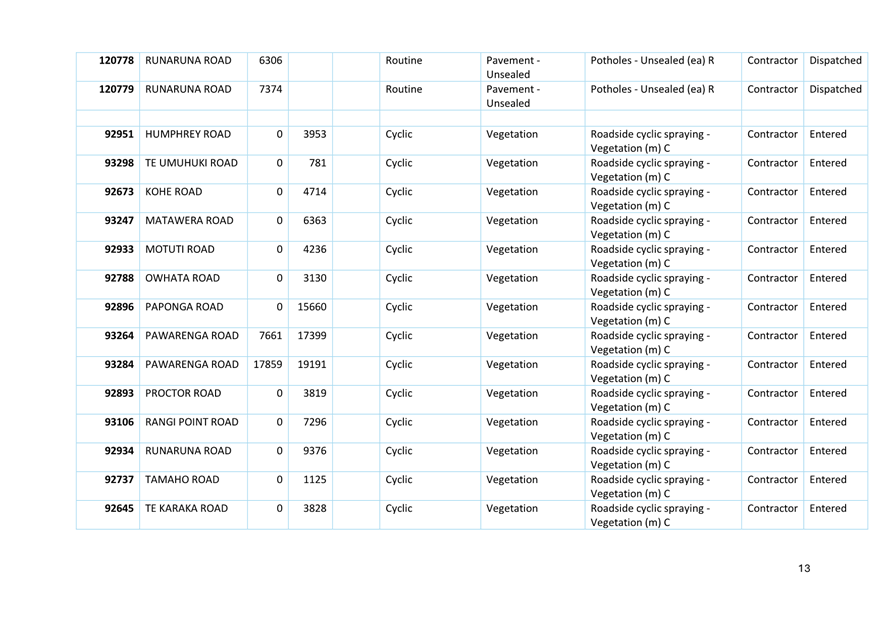

A list of tasks with blue text

AI-generated content may be incorrect.

A screen shot of a blue card

AI-generated content may be incorrect.

A screenshot of a document

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A person wearing a safety vest

AI-generated content may be incorrect.

A person taking a selfie

AI-generated content may be incorrect.

A road with a construction machine

AI-generated content may be incorrect.

A collage of a road

AI-generated content may be incorrect.

A collage of a road

AI-generated content may be incorrect.

A collage of a dirt road

AI-generated content may be incorrect.

A document with text and images

AI-generated content may be incorrect.

Ordinary Te Koukou - Transport and Infrastructure Committee Meeting Agenda

25 February 2025

A blue and white cover with a tractor driving down a road

AI-generated content may be incorrect.

A document with text and a truck on the side

AI-generated content may be incorrect.

A document with text and numbers

AI-generated content may be incorrect.

A screenshot of a graph

AI-generated content may be incorrect.

A bridge over a river

AI-generated content may be incorrect.

A close-up of a drainage system

AI-generated content may be incorrect.

A screenshot of a pie chart

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A collage of a road

AI-generated content may be incorrect.

A screenshot of a computer screen

AI-generated content may be incorrect.

A collage of a road

AI-generated content may be incorrect.

A collage of a road

AI-generated content may be incorrect.

A collage of a road

AI-generated content may be incorrect.

A collage of a road with a truck and a trailer

AI-generated content may be incorrect.

A road accident report with a truck driving down the road

AI-generated content may be incorrect.

A screenshot of a graph

AI-generated content may be incorrect.

A close-up of a document

AI-generated content may be incorrect.

A document with text and a box

AI-generated content may be incorrect.

A collage of photos of a road

AI-generated content may be incorrect.

A collage of images of a road

AI-generated content may be incorrect.

A red tractor on a trailer

AI-generated content may be incorrect.

A red border with black text

AI-generated content may be incorrect.

Ordinary Te Koukou - Transport and Infrastructure Committee  Meeting Agenda

25 February 2025

6.11       Transportation Hokianga Ferry Service Contract December 2024 Update

File Number:           A5048416

Author:                    Aaron Reilly, Operations Specialist Lighting & Transport

Authoriser:             Tanya Proctor, Head of Infrastructure

TAKE PŪRONGO / Purpose of the Report

The purpose of this information report is to provide an update on the Management and Operation of the Hokianga Ferry Service Contract for December 2024.

WHAKARĀPOPOTO MATUA / Executive SummarY

·        Contract 7/19/187 is for the Management and Operation of the Hokianga Ferry Service and Northland Ferries is the Contractor.

·        The Contract is a 10-year Contract (3+3+2+2), which commenced 1 May 2020, and the Contract is in Separable Portion 2 (SP2).

·        December was a busy month, especially over the Christmas-New Year’s Eve period when there was a marked increase in shuttling (operating continuously) to meet higher demand.

·        The ferry carried a daily average of 670 passengers and 328 vehicles in December. There were 138 shuttles during the month, six after-hours emergency callouts and 97.9% of scheduled sailings departed on time (excluding shuttles).

·        Revenue received from ticket sales (excl GST) for the month was $61,944. Revenue received compared to December 2023 was $49,818.

·        A non-conformance notice was issued to the contractor related to a staff roster issue that impacted 3 morning sailings on the 5th of December. The Contactor has satisfactorily outlined changes made to their operational procedures to avoid a future occurrence and the effectiveness of this will be monitored.

 TŪTOHUNGA / Recommendation

That Te Koukou - Transport and Infrastructure Committee receive the report Transportation Hokianga Ferry Service Contract December 2024 Update.

tĀHUHU KŌRERO / Background

Northland Ferries operates the Hokianga Ferry service under Contract 7/19/187.

Each month the Contractor provides a monthly contract report to Council and this information report provides a summary of the contract activities.

MATAPAKI ME NGĀ KŌWHIRINGA / Discussion and Next Steps

This report is for information only.

PĀNGA PŪTEA ME NGĀ WĀHANGA TAHUA / Financial Implications and Budgetary Provision

There are no financial implications or need for budgetary provision.

Tabulated below, for information is financial summary of the:

1)   Operational forecast and expenditure for the financial year to date.

2)   Revenue forecast and revenue received for the financial year to date.

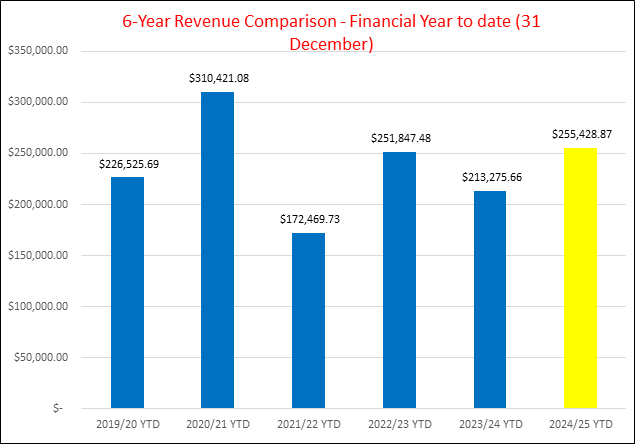

3)   A 6-year revenue comparison for the same 6-month period (1 July to 31 December).

2024/25 Operational Expenditure

Annual Forecast Budget

Expenditure to Date (31 December 2024)

Forecast from 1 January to 30 June 2025

$2,341,488

$1,000,045

$1,341,442

2024/25 Revenue from Ticket Sales

Annual Revenue Forecast

Revenue to Date (31 December 2024)

Revenue Forecast from 1 January to 30 June 2025

$500,000

$255,428

$249,572

Āpitihanga / Attachments

Nil

Ordinary Te Koukou - Transport and Infrastructure Committee  Meeting Agenda

25 February 2025

7            Te Wāhanga Tūmataiti / Public Excluded

RESOLUTION TO EXCLUDE THE PUBLIC

Recommendation

That the public be excluded from the following parts of the proceedings of this meeting.

The general subject matter of each matter to be considered while the public is excluded, the reason for passing this resolution in relation to each matter, and the specific grounds under section 48 of the Local Government Official Information and Meetings Act 1987 for the passing of this resolution are as follows:

General subject of each matter to be considered

Reason for passing this resolution in relation to each matter

Ground(s) under section 48 for the passing of this resolution

7.1 - Confirmation of Previous Minutes - Public Excluded

s7(2)(h) - the withholding of the information is necessary to enable Council to carry out, without prejudice or disadvantage, commercial activities

s7(2)(i) - the withholding of the information is necessary to enable Council to carry on, without prejudice or disadvantage, negotiations (including commercial and industrial negotiations)

s48(1)(a)(i) - the public conduct of the relevant part of the proceedings of the meeting would be likely to result in the disclosure of information for which good reason for withholding would exist under section 6 or section 7

7.2 - Kawakawa Infrastructure Acceleration Fund - Detailed Design Procurement

s7(2)(b)(ii) - the withholding of the information is necessary to protect information where the making available of the information would be likely unreasonably to prejudice the commercial position of the person who supplied or who is the subject of the information

s7(2)(h) - the withholding of the information is necessary to enable Council to carry out, without prejudice or disadvantage, commercial activities

s48(1)(a)(i) - the public conduct of the relevant part of the proceedings of the meeting would be likely to result in the disclosure of information for which good reason for withholding would exist under section 6 or section 7

Ordinary Te Koukou - Transport and Infrastructure Committee  Meeting Agenda

25 February 2025

8            Karakia Whakamutunga / Closing Prayer

9            Te Kapinga Hui / Meeting Close
